|
Location
|
Public School in Kandal Province - South West of the
Capital Phnom Penh on the road to Vietnam
|
School Details
|
1,100 Primary School Students attend this school, 6
days per week
|
Issue
|
The school has 2 working toilets for all the students
and this creates hygiene issues and frequent illnesses
|
Our Project
|
Knock Down the 3 ancient non-working toilets
Build a 5 toilet block
New Septic tanks
2 Side Water Supplies
Existing 2 working toilets to remain
|
Cost
|
$15,000 Australian Dollars (based on being able to get
exchange rate of 70c US Dollar - fingers crossed)
|
What is included in the price
|
Supplies - Brick, Metal, Sand, Septics, Tile, Toilet
Furniture, etc
Builders - To demolish and remove the old 3
non-working toilet block, old septics and old water supplies;
Excavate and install new septics and water supplies; Build
toilet block
Project Manager - This is essential in
Cambodia. A local trusted person to pay the required
amount needed to do the days work and to check the previous days
work was completed. Also to provide photos and updates for this
website
Allowance - For a 10% overrun in costs during
the build and also to insulate against a possible still
plummeting Australian Dollar versus the US Dollar. If this
is not needed in its entirety it will be put towards the next
project
|
Goal
|
As of 06/04/2016 we have $8,630 generously donated and
have $6,370 to go
|
Planned Building Start Date
|
28th March 2016 - Past Due Date as of 06/04/2016 - to
start in the next few days, see below milestones for details
|
Current Project Key Milestones
-
October 2015 - Scouting for next project
-
January 19, 2016 - Primary School selected and visited
-
January 23, 2016 - Full Quote for Supply, Build and Project Management
Obtained
-
Current Funding being obtained and then money to metered
out to the Cambodian Project Manager once available
-
Planned Build Start Date 28th March 2016
-
31st March 2016 - We have been distracted with our normal
jobs, and planned start date missed due to insufficient funds.
Start has to be delayed by a few weeks to save the amount needed to
cover the balance required.
-
Next Visit to Cambodia and this School is now the 29th
April 2016 and the project needs to commence before then so we will
update soon with the revised start date for this project
-
Photos of progress to be posted after our next visit at
the End of April where we will personally take some
-
April 6, 2016 - Project is short of the funds total but we
thank everyone so much for their donations. We have been
promised some more yet to be received and we will make up the
difference personally (we will keep saving while the project is
running). Thank you all for contributing so generously to help
our little project. If you have not donated and would like to or
intend to, that would still be greatly appreciated
-
April 6, 2016 - The first amount of $1,500 AUD has been
sent electronically (converted to USD) to the project manager to start the demolition
of the existing toilet block and septic tanks. Earthworks are
next to be able to install the two new underground septic tanks. I
will personally take photos to post here when I am there at the end
of this month. Posting of the progress photos will occur on my
return in early May
-
May 16, 2016 - I have returned from Visiting the School in
Cambodia. The construction has begun and about 50% of the way
through. While there I paid suppliers and builders a total of
$7,500 AUD. See the bottom of this page for progress photos.
The final price will be about $2,500 Australian dollars less than
the $15,000 target we originally budgeted for. The build is
planned to be finished within 4 weeks and the last amount of $3,500 AUD
inclusive of approximate transfer costs to be sent by 17th June. We are currently
saving for that last payment.
-
May 17, 2016 - The school wants a ceremony and a
plaque erected to say thank you. I insisted that we do not want any
personal recognition and we agreed upon a sign carved from
wood to say Australia with a Kangaroo symbol on it to be
commissioned . We intend to
visit again in early August to see it finished and to have the ceremony.
We will also be scouting and visiting other schools to
select the next project
-
May 22, 2016 - $1,000 AUD of the outstanding $3,500 sent
to Cambodia. $2,500 to save now to complete the project. More
progress photos uploaded, see bottom of this page
-
June 3, 2016 - $1,000 AUD of the outstanding $2,500 sent
to Cambodia. $1,500 to save now to complete the project. More
progress photos uploaded, see bottom of this page
-
June 18, 2016 - $1,500 AUD, the last payment converted
into USD sent as last payment for the build. Finished photos
uploaded below. Last task it to pay a little bonus to the Project
Manager for bringing this in under budget and getting it looking so
good. Then will go to the School in the next 8 weeks for opening
Ceremony
-
It took longer than we hoped but there was a return to the
School in October, unfortunately it is rainy season and long school
holidays for the children. The school principal, school
manager and some teachers were there to say thank you. They
took some photos together and presented me with the certificate
(picture of this already shown below). The nice think was
there was two certificates one in Khmer and another in English for
my benefit. I ensured they only reference Australia not us
personally for the recognition of the charity given. The
showed the toilets and they looked even better than the photos show,
we are very proud of them and the great building job that was done
and control by our project manager Sawy. There are locks on
the toilets now as it is known in the area how good the new toilets
are. There is a market next to the school and the general
public was using them on weekends when the school was empty.
On this quick two day trip we visited another primary school,
another 45kms closer to Vietnam from this one. Similar size
and issues. We may be doing the same at this new location so
will move this page to it's own page now it is finished and start
the new school in the possible Live
Project page. Hopefully can have a short visit back to the
school possibly in January to start to quote and organise what needs
to be done.
Photo Array
(I am not an expert website builder and do not
know how to make the photos a thumb and click to zoom, so for a closer
look please zoom manually, for example in Internet Explorer, Ctrl +
(zoom), Ctrl - (reduce) and Ctrl 0 (back to normal size))
Entrance
|
Entrance
|
Main
Classroom Building
|
Main Classroom Building
|
Main Classroom Building is "L"
Shaped
|
"L" Part on Main Classroom Building
|
"L" Part on Main Classroom Building
|
Main Classroom Building is "L"
Shaped
|
Main Classroom Building is "L"
Shaped
|
2nd Classroom Building (Toilets
Behind this)
|
2nd Classroom Building
|
2nd Classroom Building
|
2nd Classroom Building (Toilets far
end)
|
Non-Working Toilet Block to be
demolished
|
Non-Working Toilet Block to be
demolished
|
Background is the 2 Toilet Block -
keeping
|
Non-Working Toilet Block to be
demolished
|
Background is the 2 Toilet Block -
keeping
|
2 Toilet Block - To Remain
|
School Manager
|
Classroom
|
Classroom
|
School Grounds
|
School Grounds
|
School Grounds
|
School Grounds
|
School Grounds
|
School Grounds
|
School Grounds
|
School Grounds
|
School Grounds
|
School Grounds
|

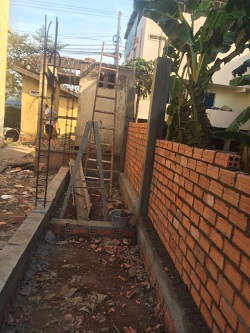

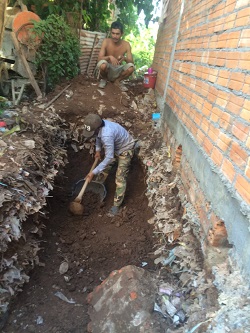

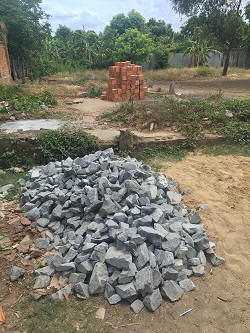

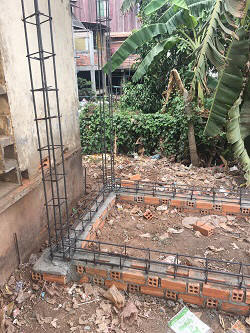

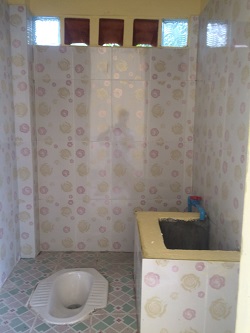

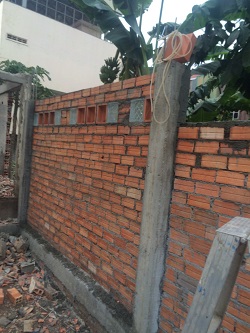

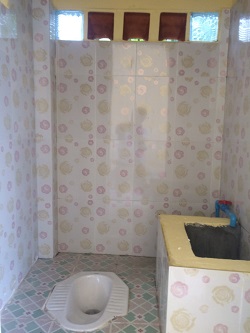

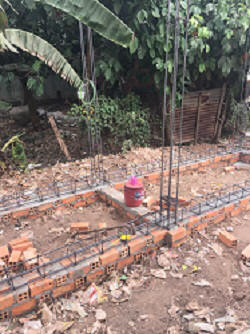

Photo Array - Progress of the Build
