|
Location
|
Public School in Kandal Province (Or could be in Prey
Veng Province, we have been there but not sure where the borders
are, we are awaiting confirmation of exact province this is in) - South West of the
Capital Phnom Penh on the road to Vietnam. About 45km
closer to Vietnam than the last completed project at
Prek Eng Primary School
|
School Details
|
1,000 Primary School Students attend this school, 6
days per week
|
Issue
|
The school has 2 working toilets for all the students
and this creates hygiene issues and frequent illnesses
|
Our Project
|
Build a 5 toilet block

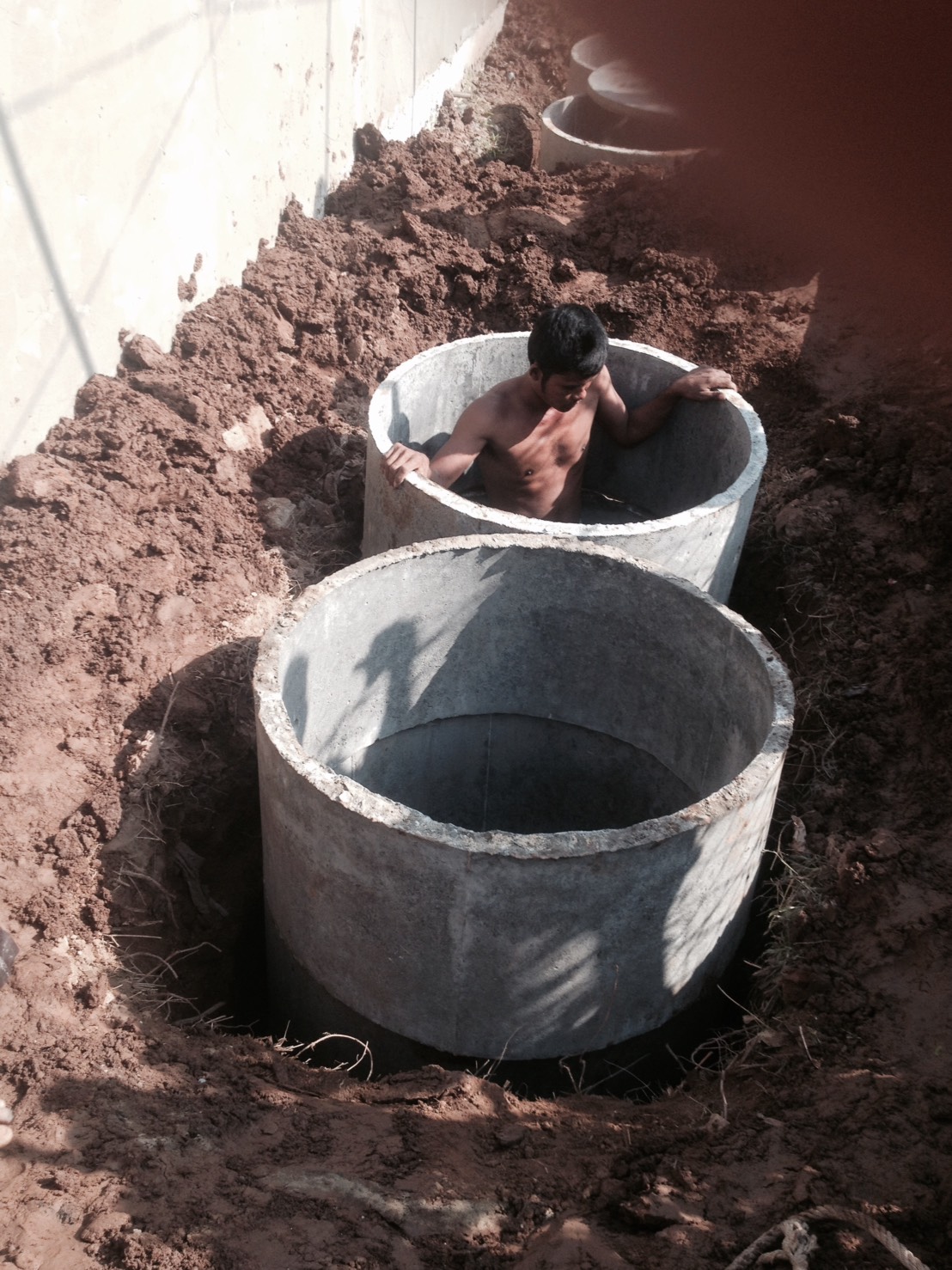

New Septic tanks
Water Supply
Existing 2 working toilets to remain
|
Cost
|
Unknown, too early to tell, one one visit so far, next
visit formal quotes will be done, we assume the cost will be
around $10,000 Australian Dollars (based on being able to get
exchange rate of 75c US Dollar - fingers crossed)
|
What is included in the price
|
Supplies - Brick, Metal, Sand, Septics, Tile, Toilet
Furniture, etc
Builders -
Excavate and install new septics and water supplies; Build
toilet block
Project Manager - This is essential in
Cambodia. A local trusted person to pay the required
amount needed to do the days work and to check the previous days
work was completed. Also to provide photos and updates for this
website
Allowance - For a 10% overrun in costs during
the build and also to insulate against a possible drop in Australian Dollar versus the US Dollar. If this
is not needed in its entirety it will be put towards the next
project
|
Goal
|
TBA - Have only visited the site once, timing will be
determined after that
|
Planned Building Start Date
|
Unknown
|
Current Project Key Milestones
-
October 2016 - Scouting for next project and Primary School selected/visited
-
Possible visit January 2017 - Full Quote for Supply, Build and Project Management
to be obtained
-
Visit for first quotes and discussion with builder did not occur
until 4th March 2017. Talks went well and there will need to
be another visit to finalise the plans on what is to be built but
the quote roughly above has improved from roughly $12,500 AUD to
about $10,000 AUD. The school asked if it was possible to
build more than 5 toilets. I advised them, that they can have
as many as they want but it will take longer to save. We
agreed to still to the 5 so some are built this year and we may
build some more there at a later date.
-
Easter 2017 and Terri and Deb from my work kindly paid for and
organised a chocolate egg raffle. This raffle and some direct
donations equated to $720 being raised. I am blown away by
everyone who wants to help this little project.
-
July 2017 - Our savings has progressed well, together with the
raffle from Easter and some other kind donators (you know who you
are and I cannot thank you enough) has reached $5,000 AUD. A
last visit is needed to Cambodia to finalise the quote and move
towards a build date.
-
19th August 2017 - Phnom Penh visited. Total cost of supplies,
building and project management will come in at $9,800 AUD.
Start date to be selected after the current wet season (torrential
rains) have ceased
-
18th October 2017 - Wet season subsiding and build date planned
to commence on 7th November 2017
-
29th October 2017 - Total savings and donations has just passed
$8,000 AUD. The build will commence on the agreed 7th
November. The last $1,800 AUD is being saved as quick as
possible to be ready before the end of the build. First amount of
$2,000 USD to be sent to the project manager on 4th November 2017 to
start the build on the 7th November
-
Thank you to all who have helped us and donated. The last
$1,800 will be a push but the savings will get there. Thank
you all once again.
-
Once the build commences please visit here to see the progress
photos (below) and milestone updates to show your generosity at
work.
-

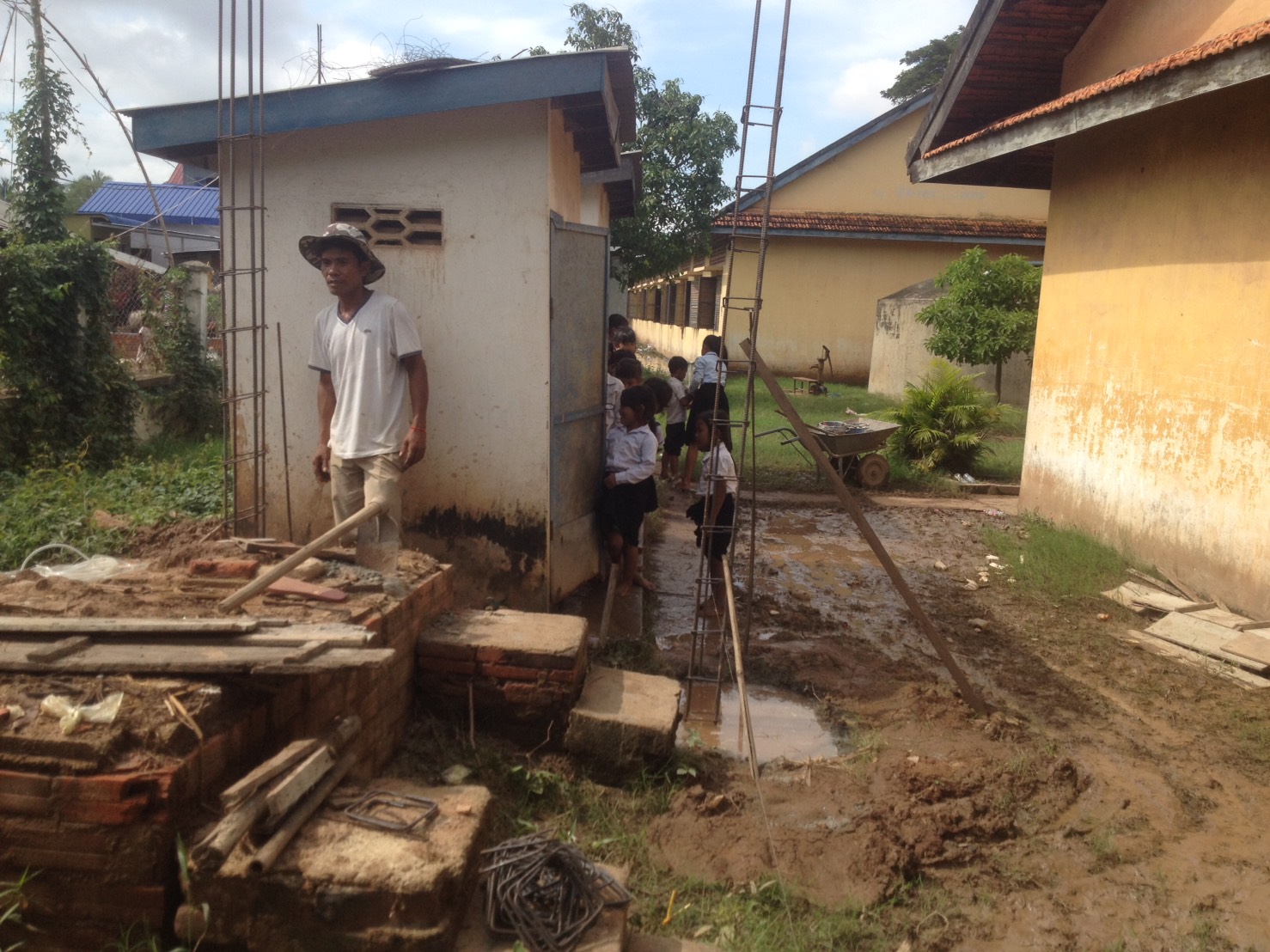

Building commenced 1 week after the proposed start date of the
7th November. Initially that date was moved to the 11th and
then moved again with an actual start on 14th November. The
delay was due incessant longer than normal rainy season.
-
First 20% of the budget was sent to Cambodia on 5th November.
-
The next 4 instalments of the remainder of the 80% budget has
been sent in 20% instalments when required. The last transfer
being on 22/12/2017. The progress has been fast in 6 weeks. I
am waiting for more photos as the last remaining work as of
24/12/2017 is the tiling, toilet furniture, doors and painting the
outside. Will be good to see the next photos with the roof one
and the septics finished and water connected.
-
The last 20% of the budget sent on 22/12/2017 is supposed to
cover all the remaining works. However there is a possibility
we will go over budget due to the changing cost of some of the
supplies, but it will be small. It is envisaged it will be a
maximum of $500 USD over. If required this will be sent at the
end of the project.
-

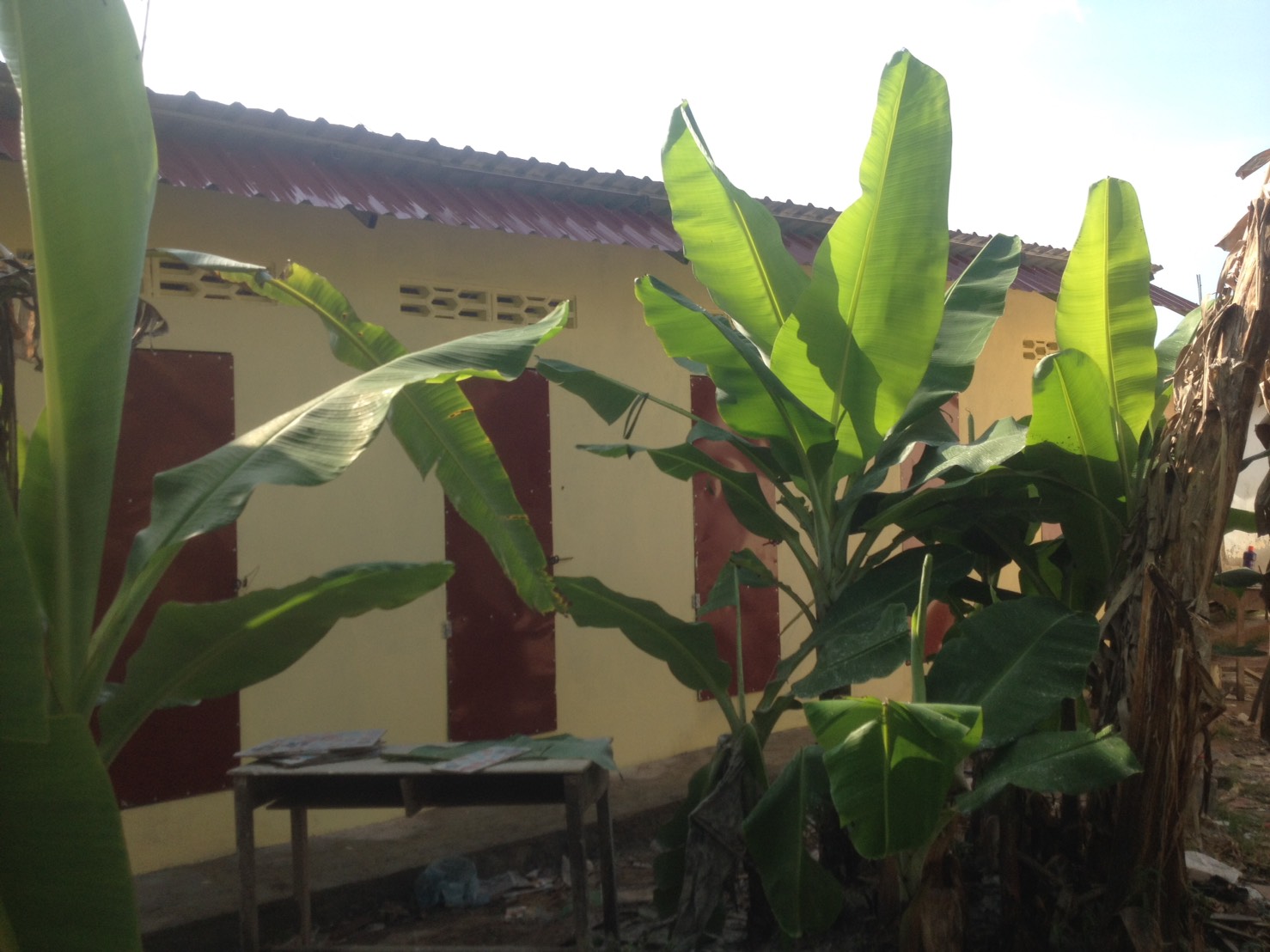

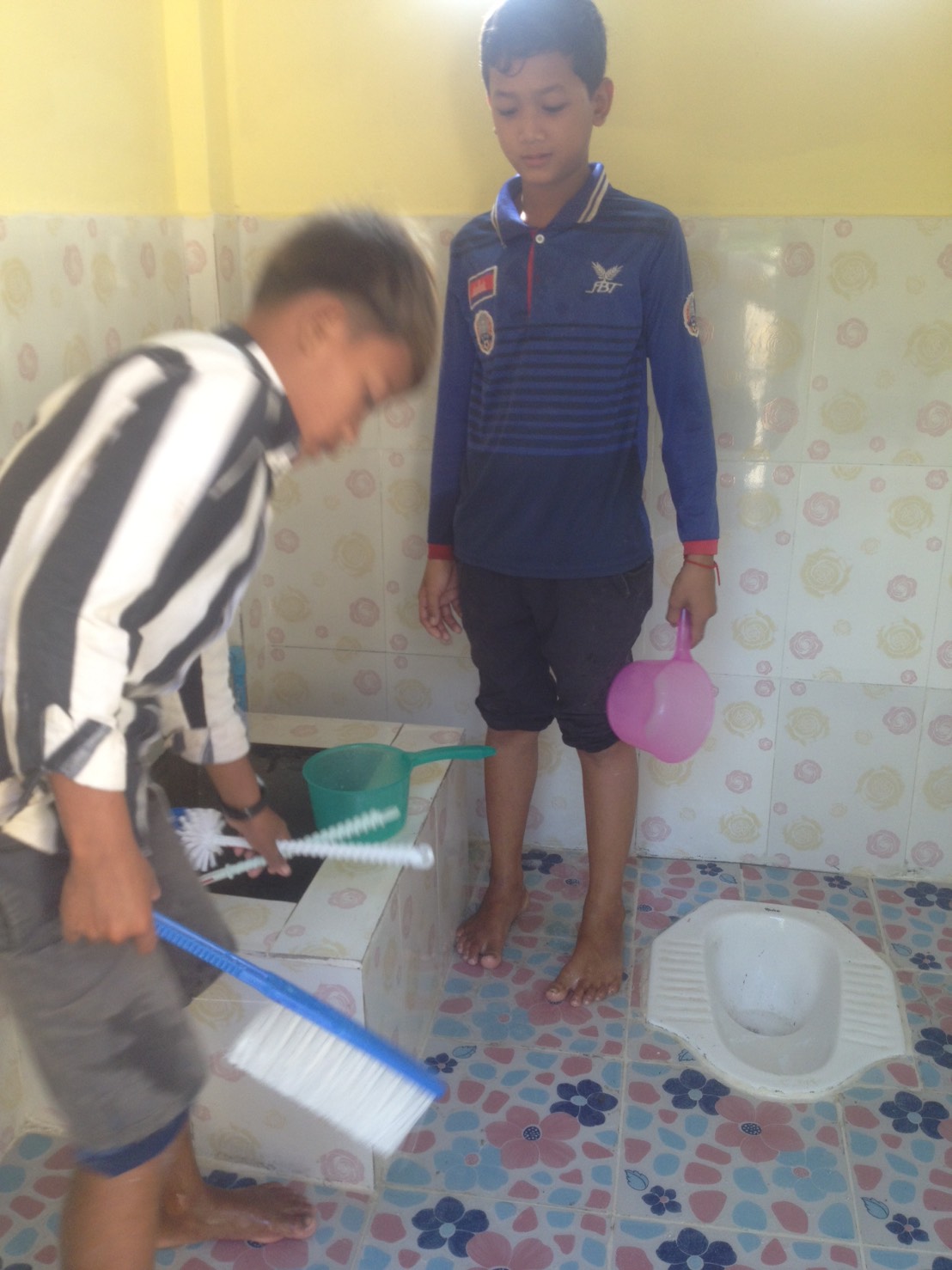

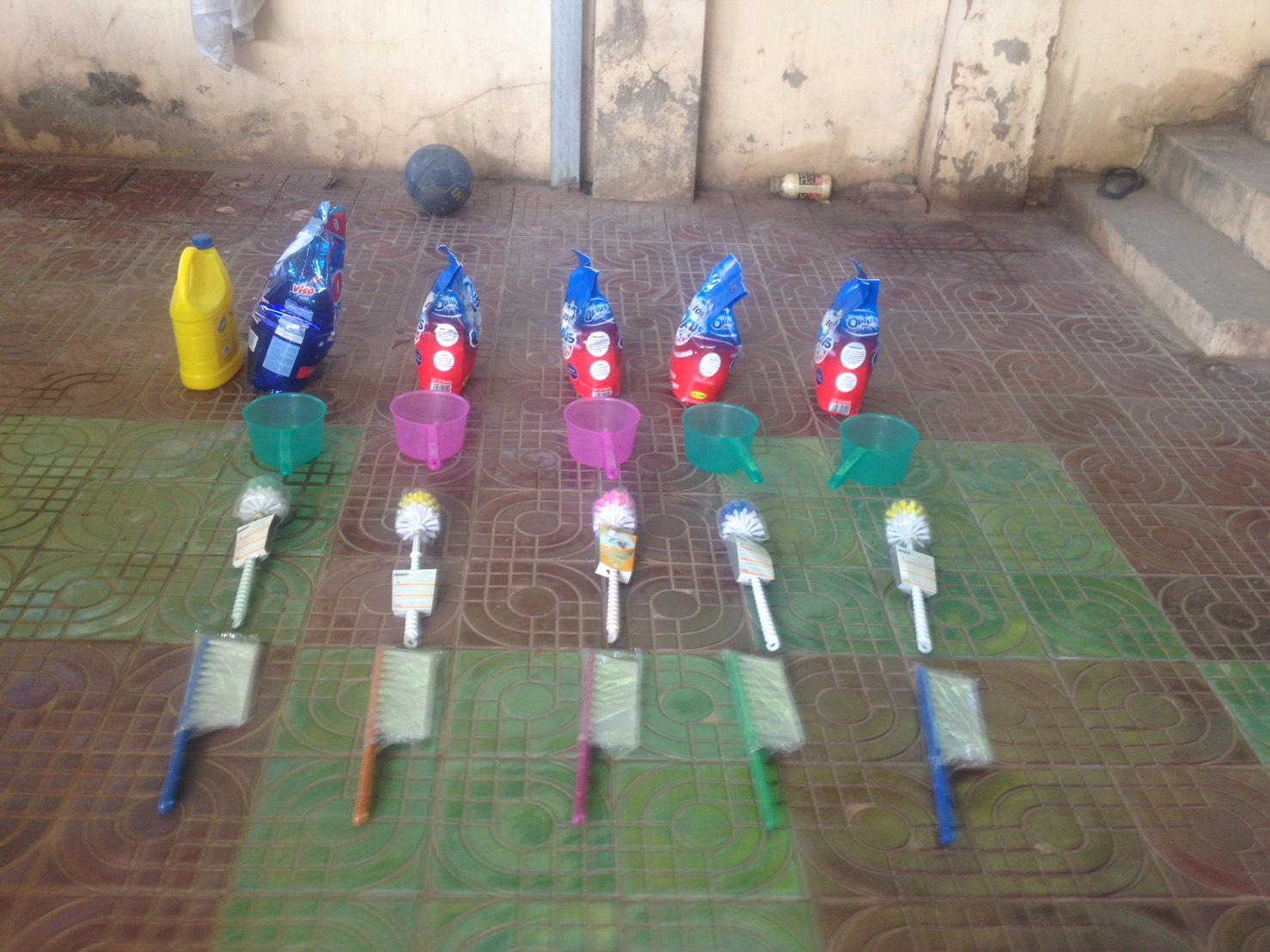

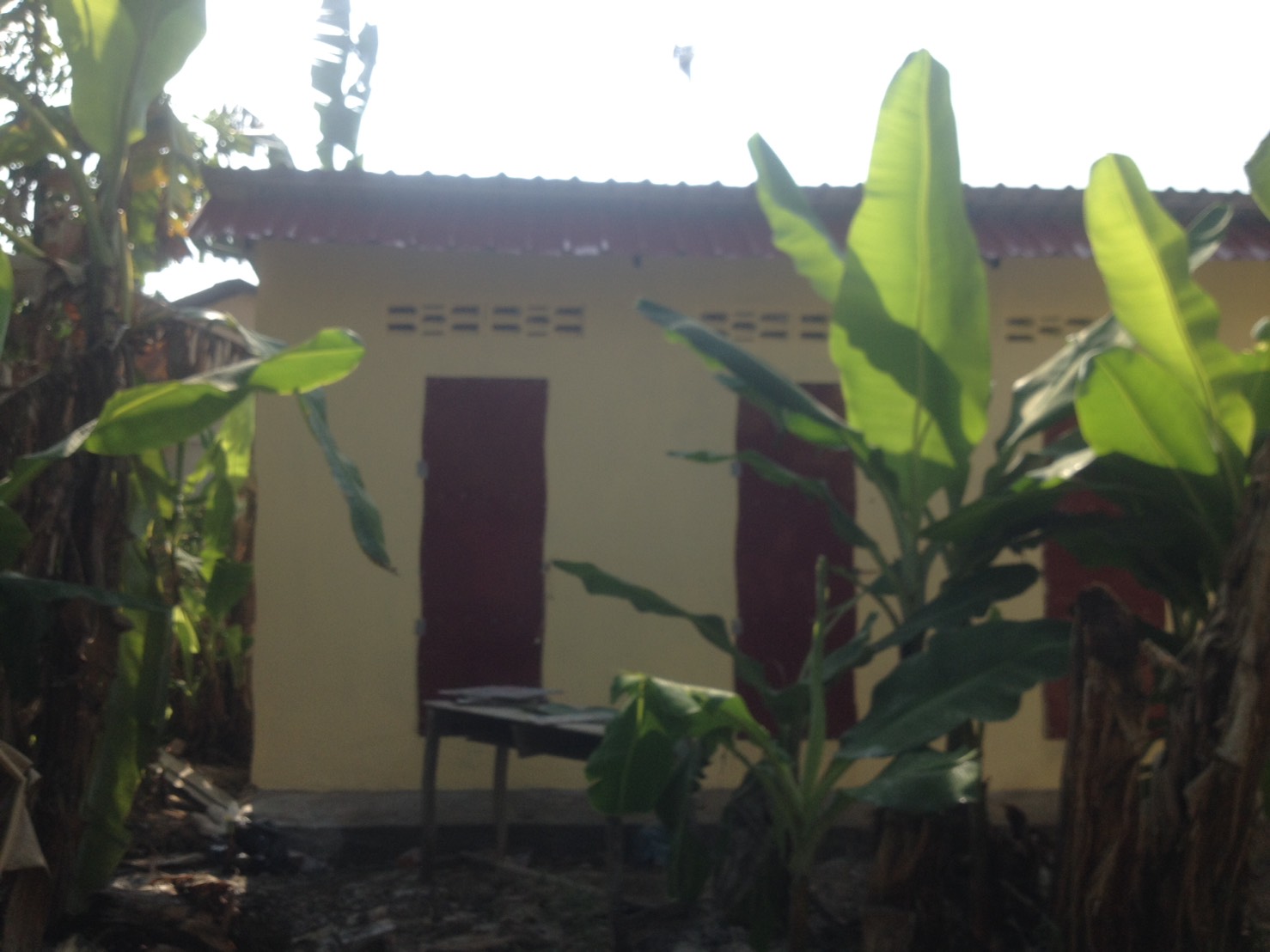

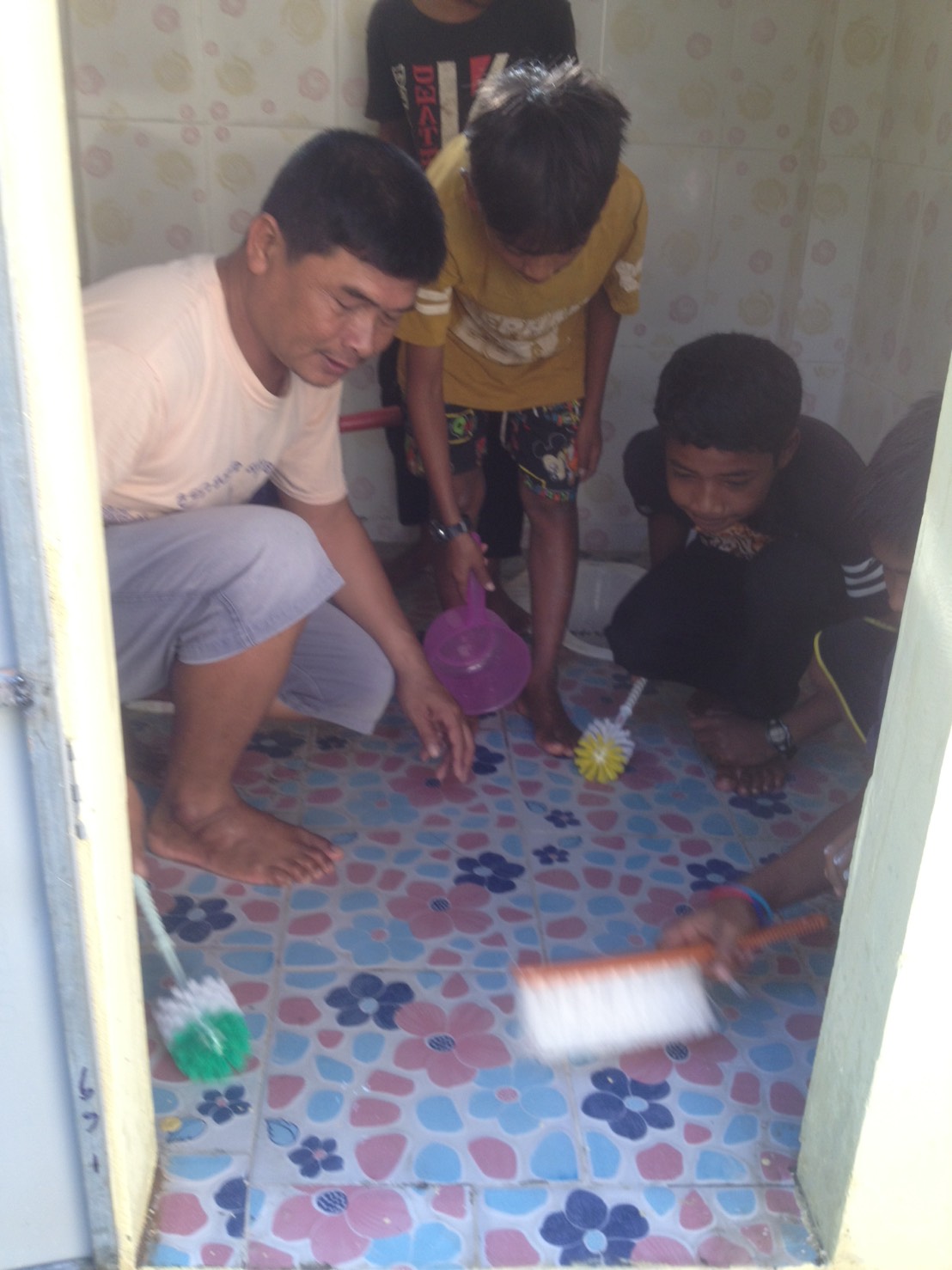

Project finished, cleaned and ready for use on 13th January
2018. Thank you all for your support and generous donations.
-
Visit of the completed project will occur in the middle of March
2018

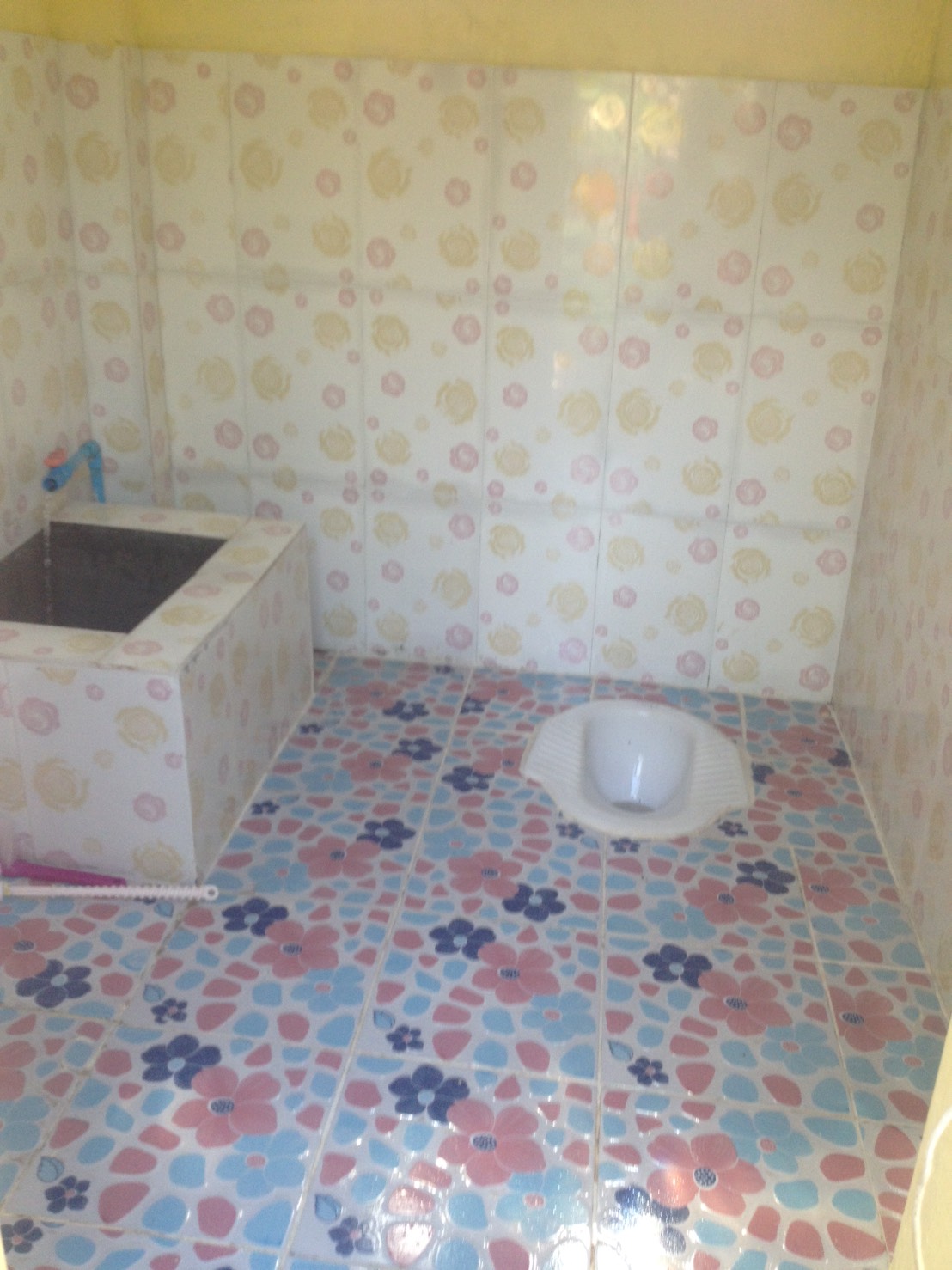

Photo Array
(I am not an expert website builder and do not
know how to make the photos a thumb and click to zoom, so for a closer
look please zoom manually, for example in Internet Explorer, Ctrl +
(zoom), Ctrl - (reduce) and Ctrl 0 (back to normal size))
Entrance
|
Entrance
|
Entrance
|
Main Classroom Building
Could not get a good photo in wet season
|
Main Classroom Building is "L"
Shaped
|
Back of the "L" Shaped main
building and to the left of this is the existing 2 toilets
|

Existing 2 Toilets for 1,000
students
|
Existing 2 Toilets
|
Existing 2 Toilets
|

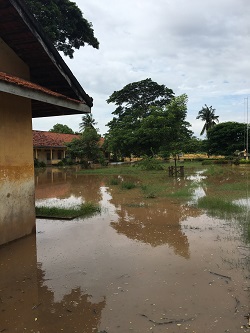

School Grounds Wet Season
|
School Grounds Wet Season
|
School Grounds Wet Season
|
School Grounds Wet Season
|
Other Classroom Building
|
Other Classroom Building
|
Lunch area and behind the school is a big pagoda area with many
temples
|

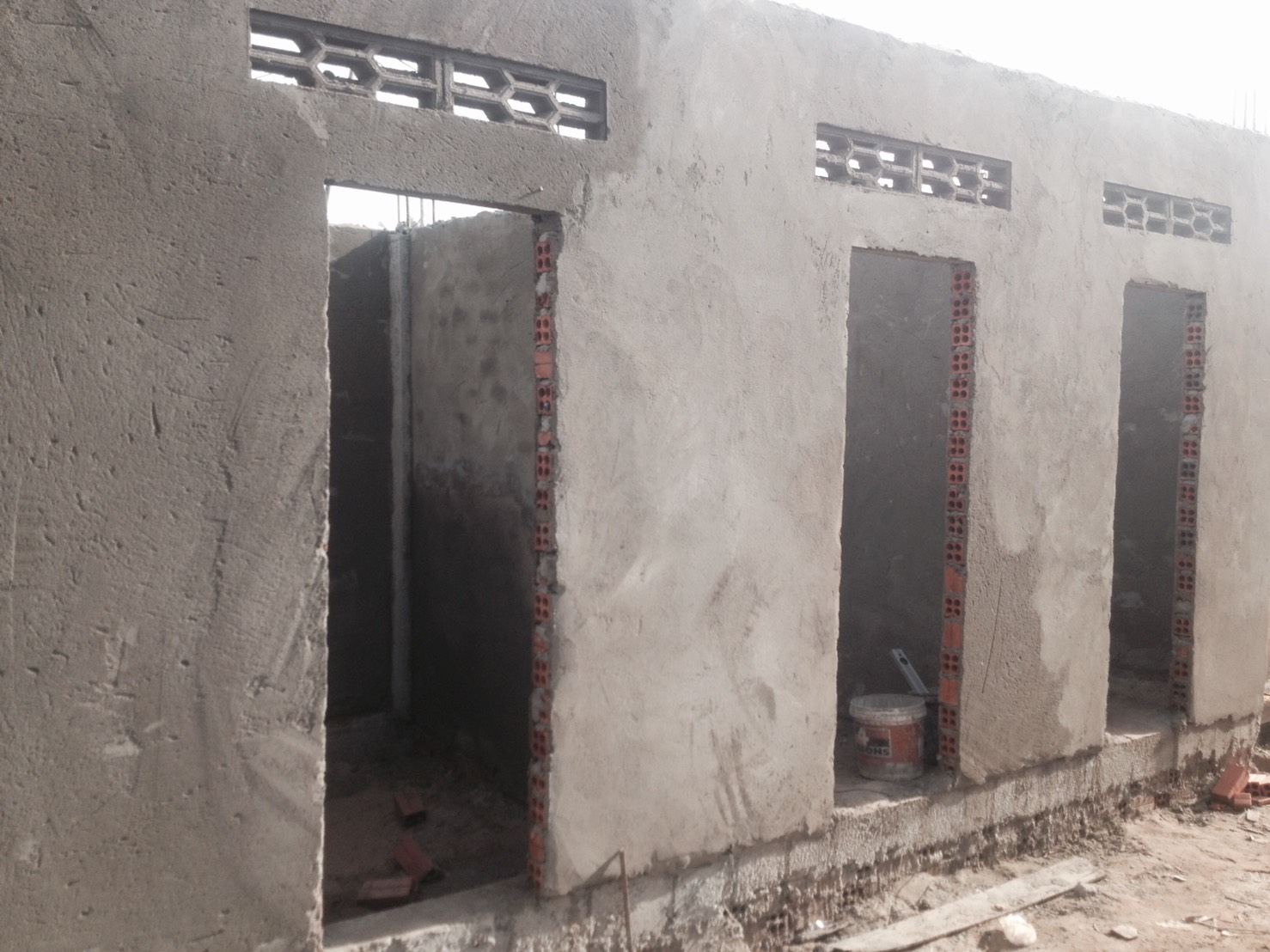

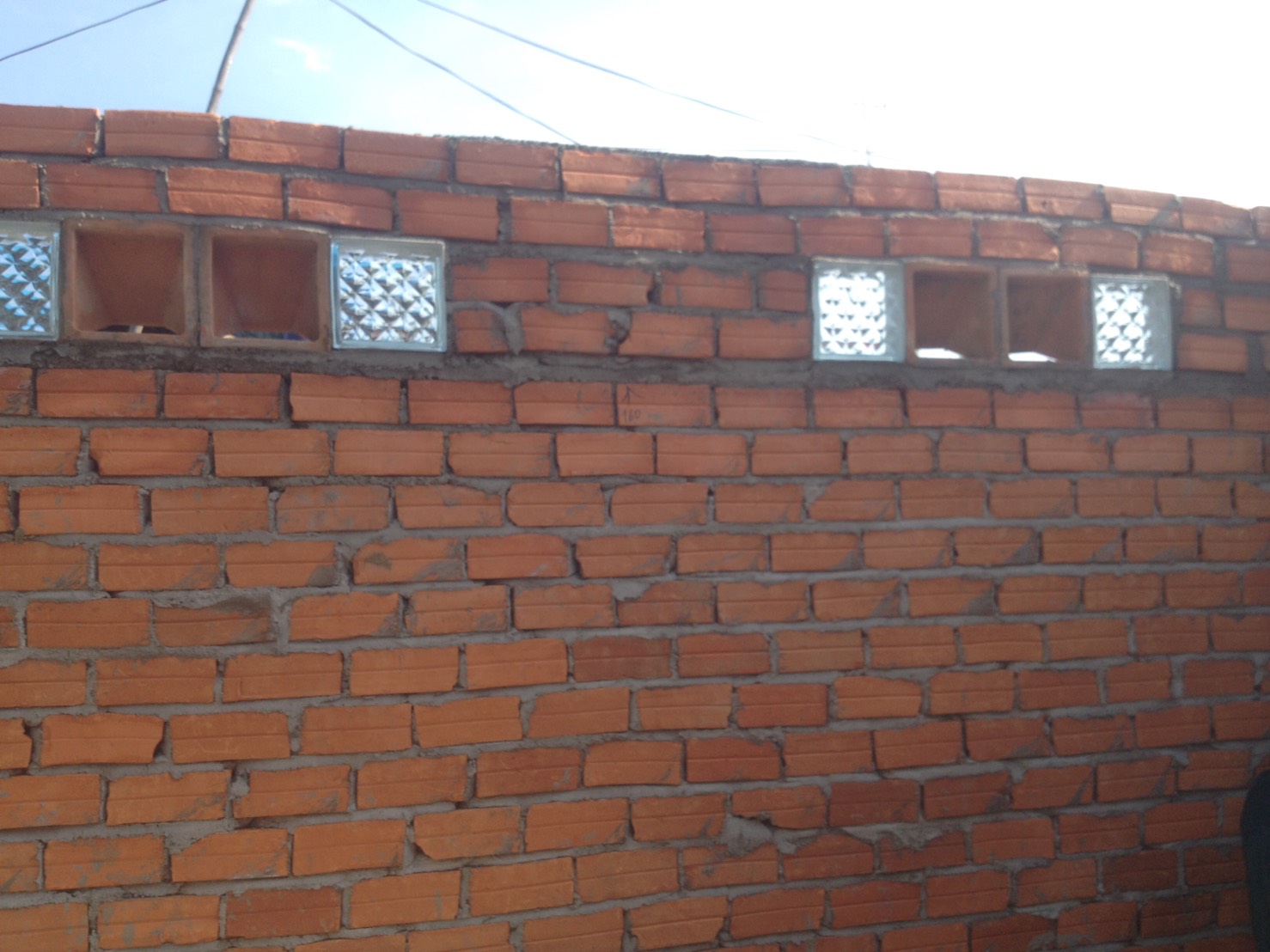

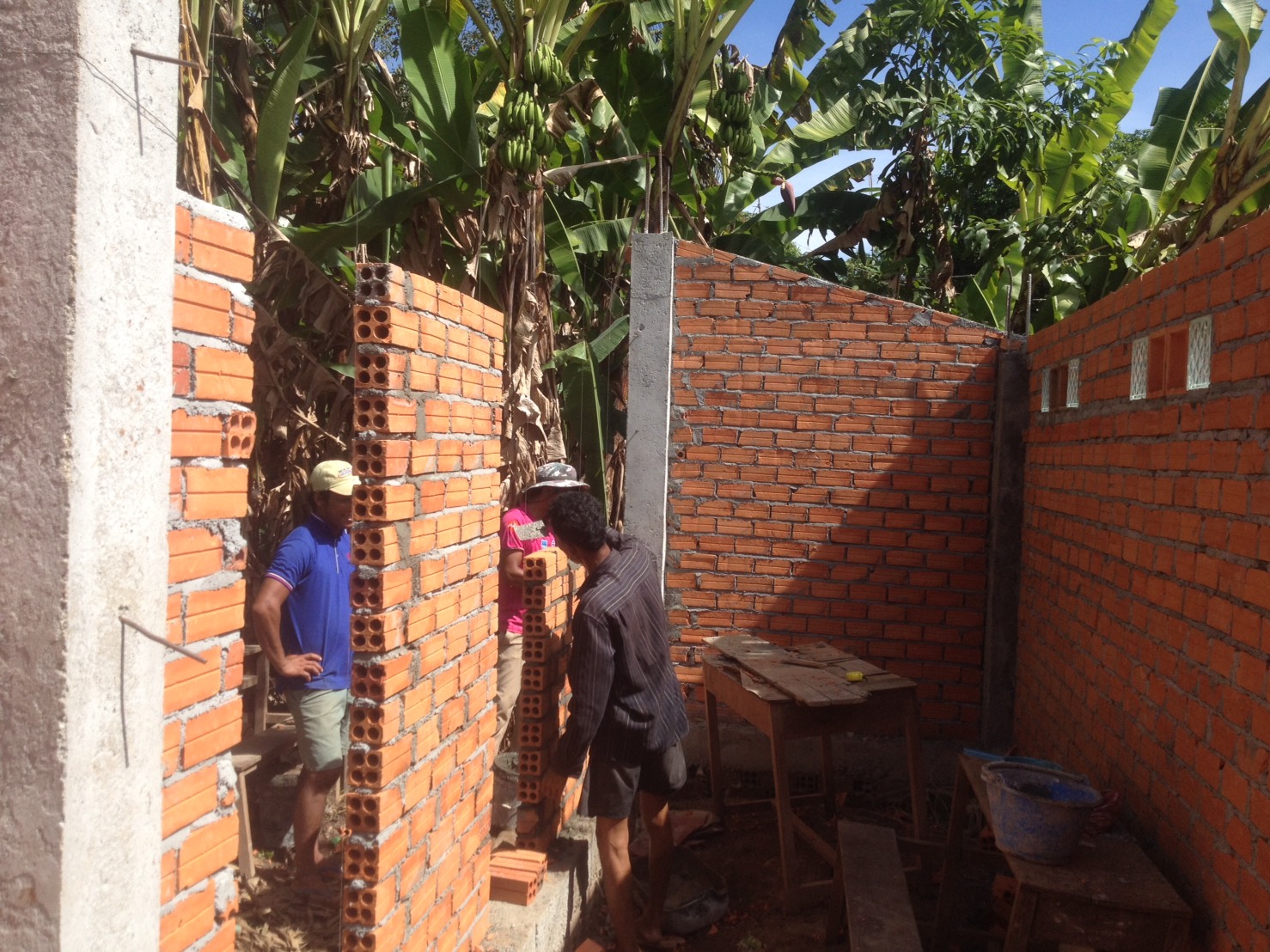

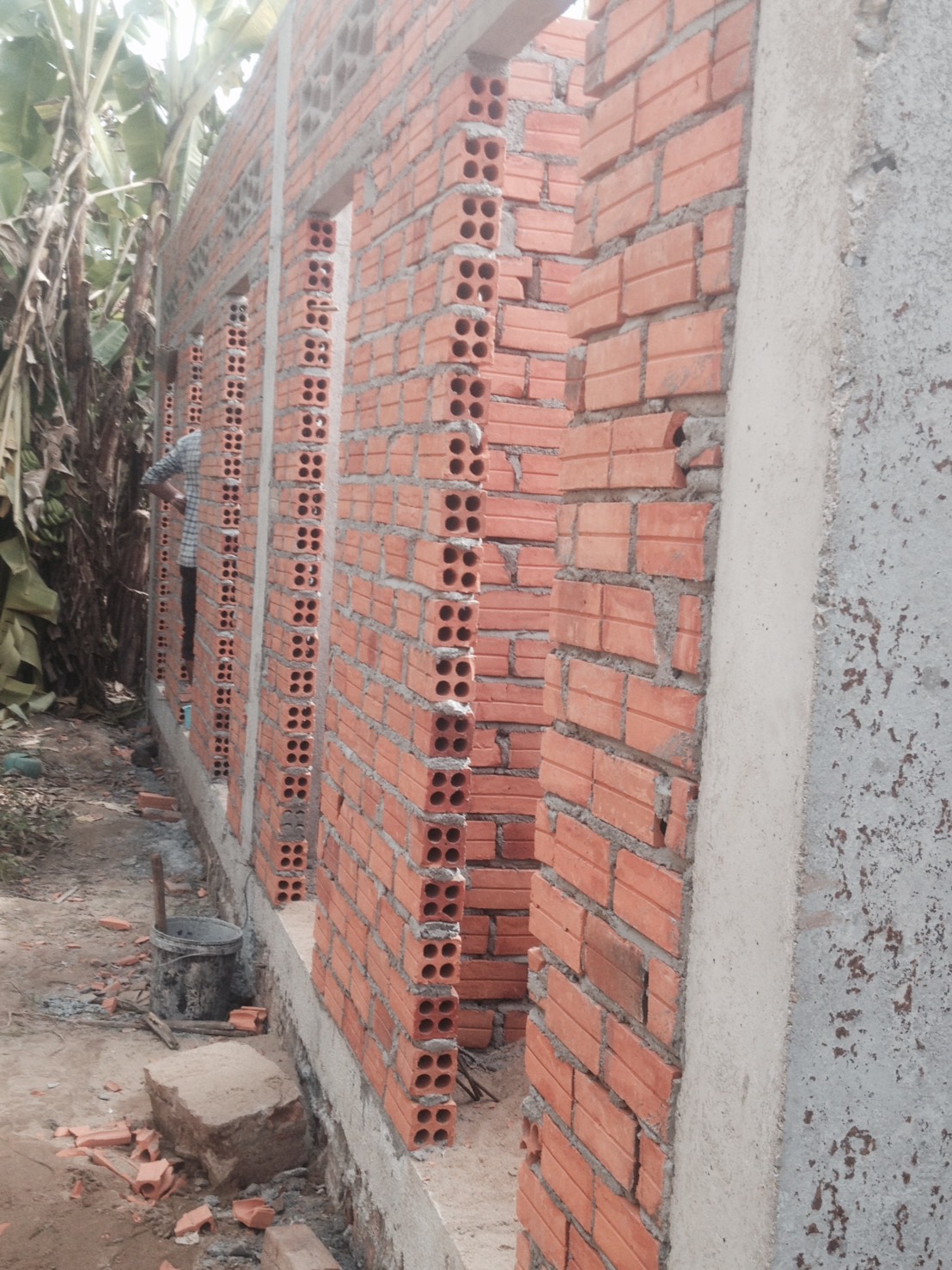

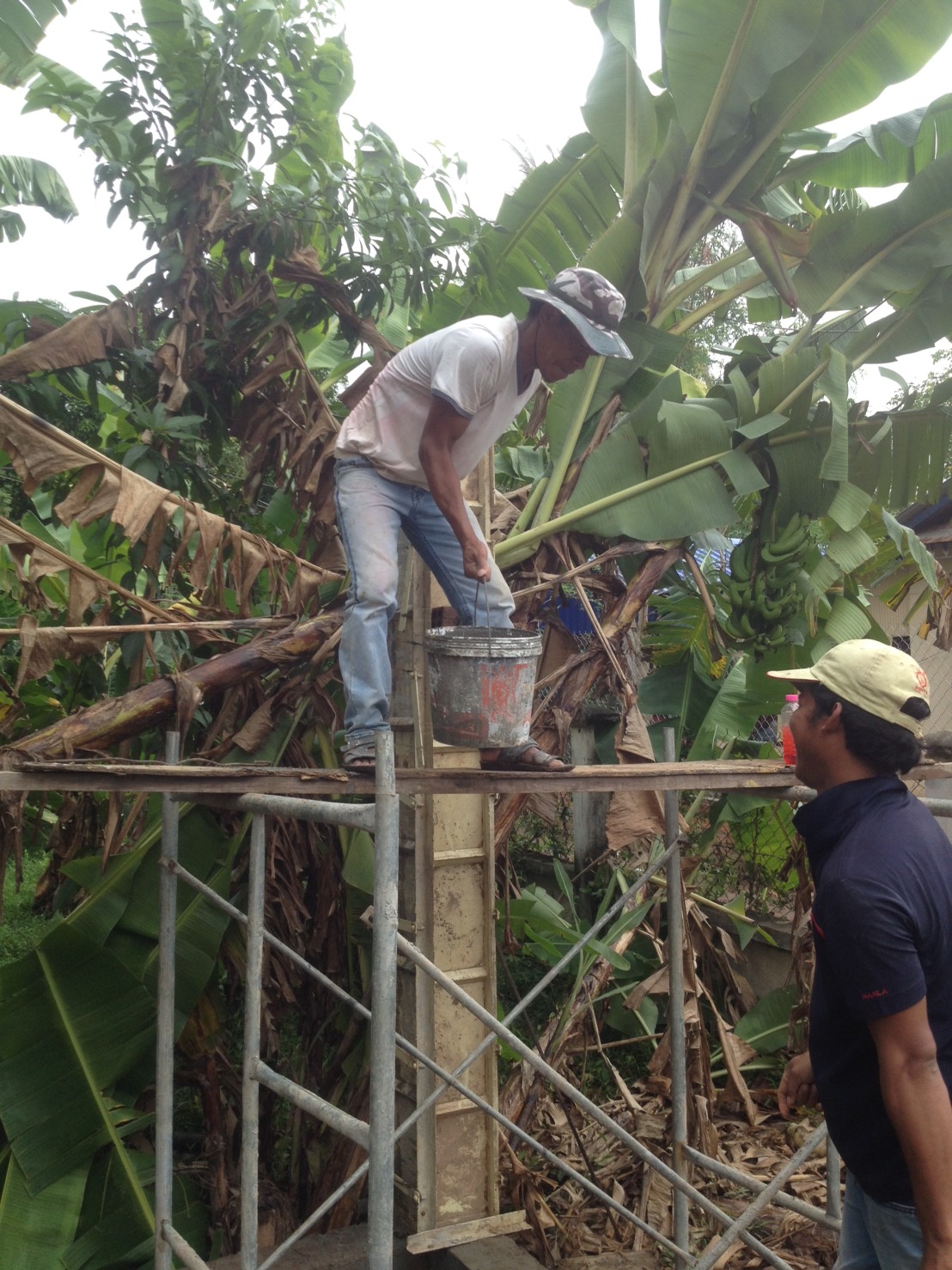

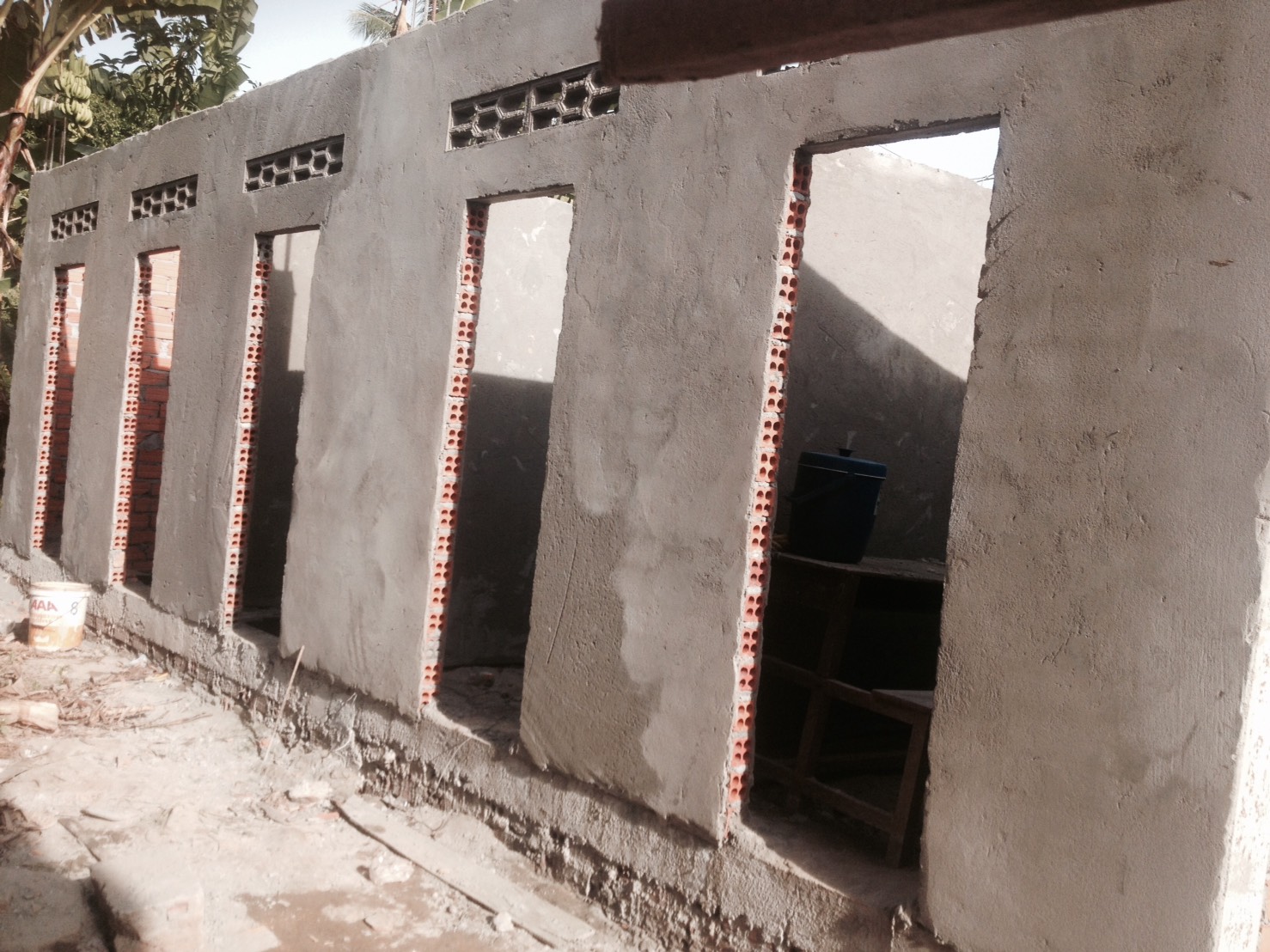

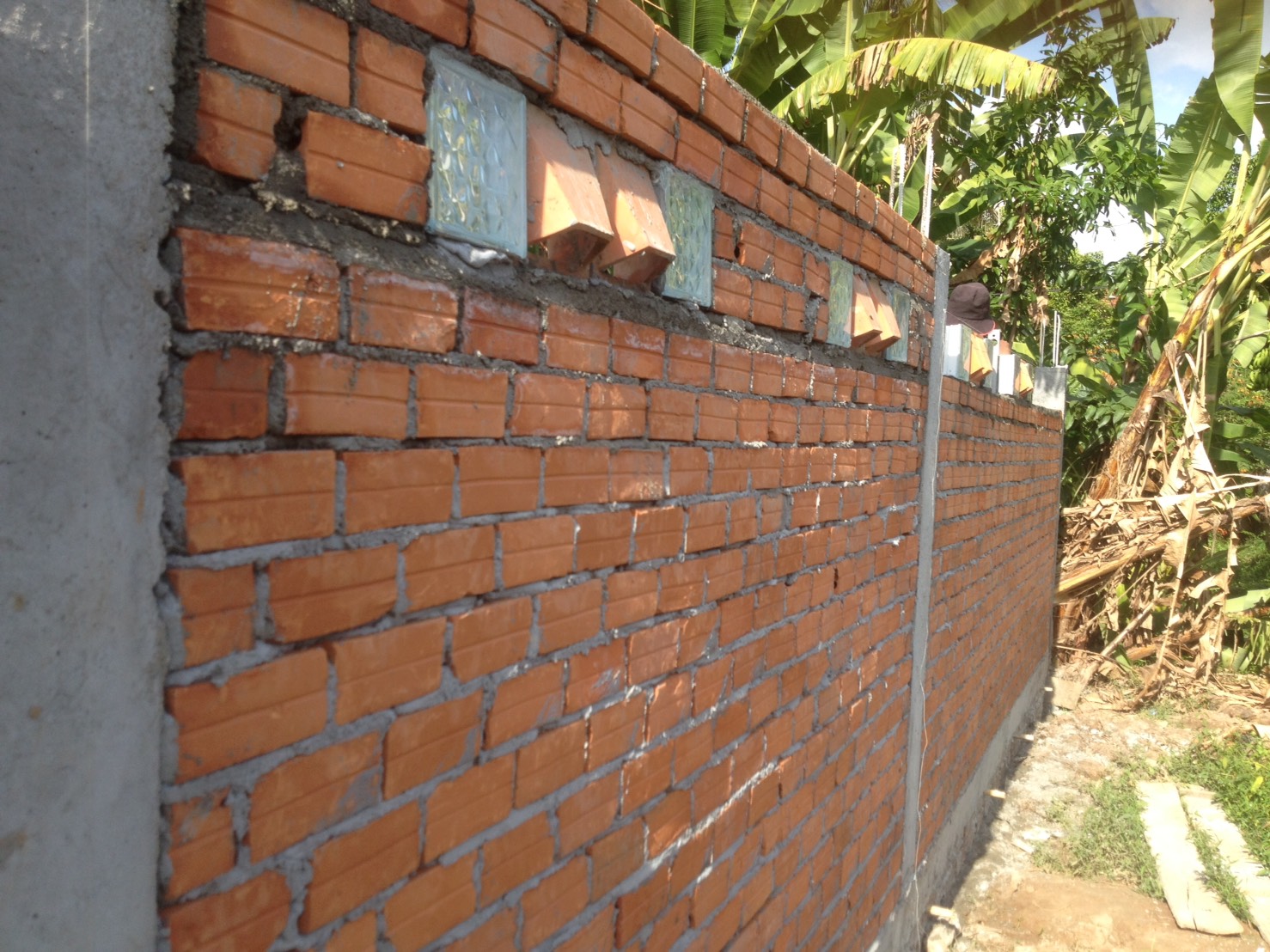

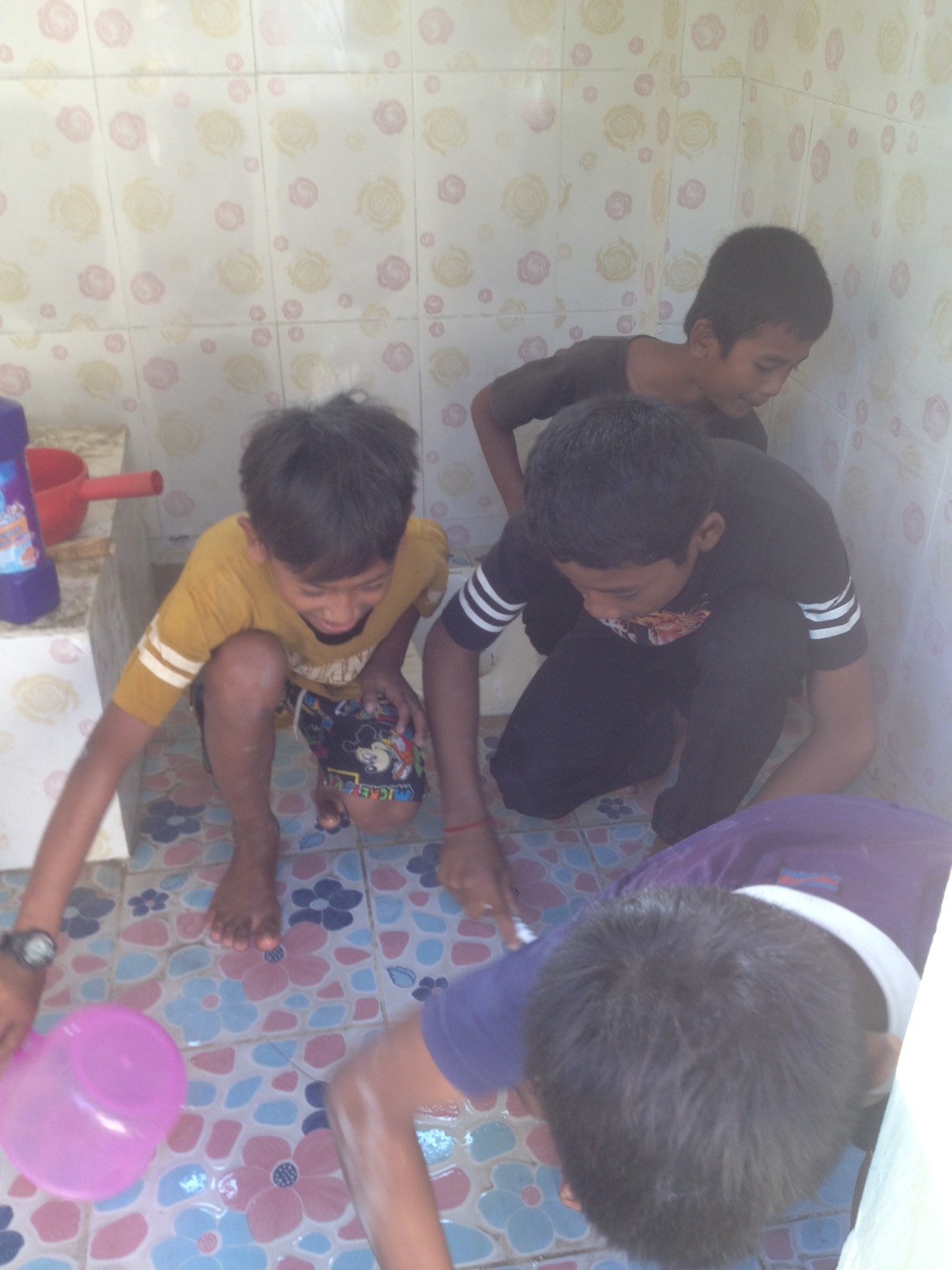

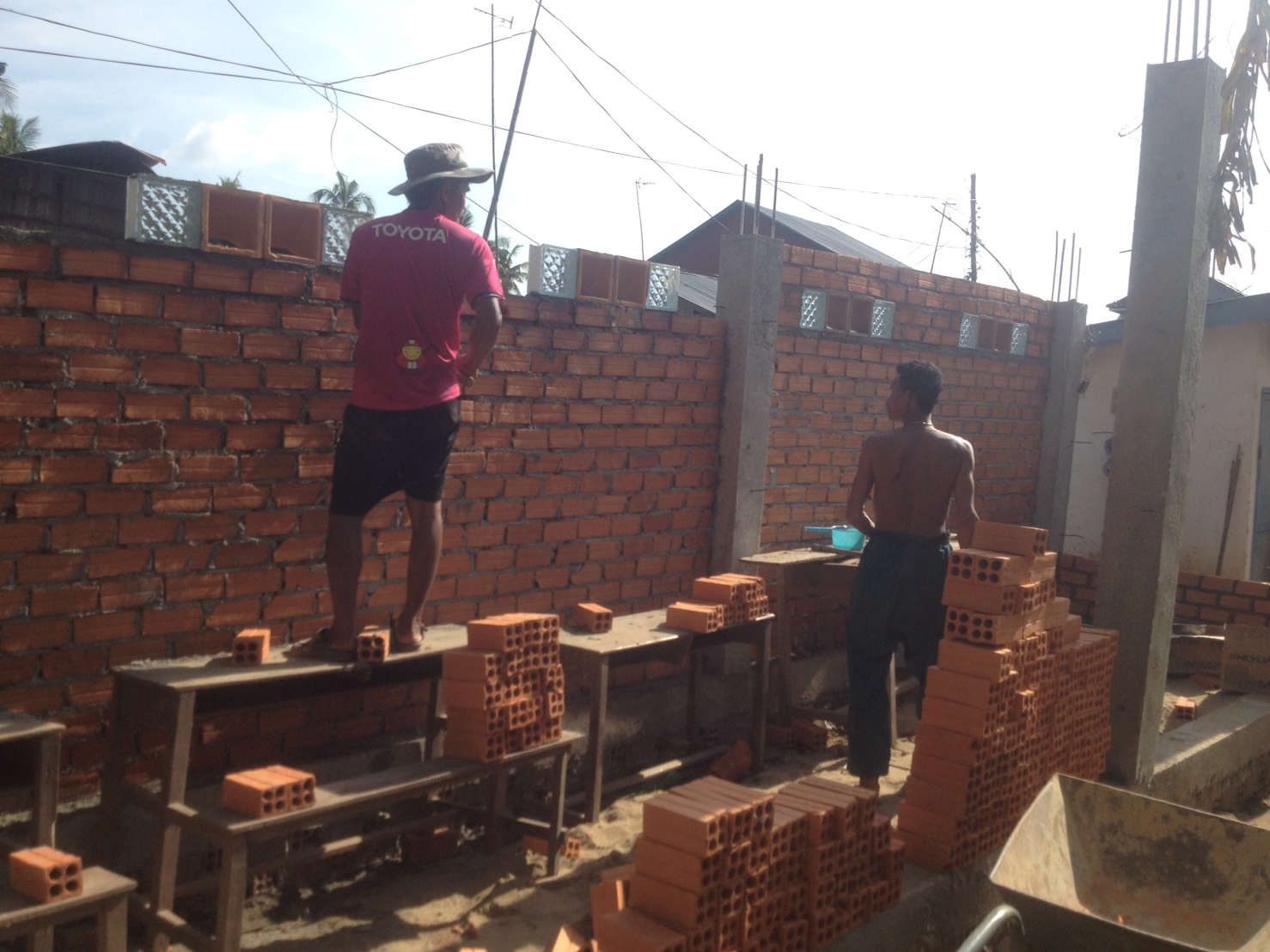

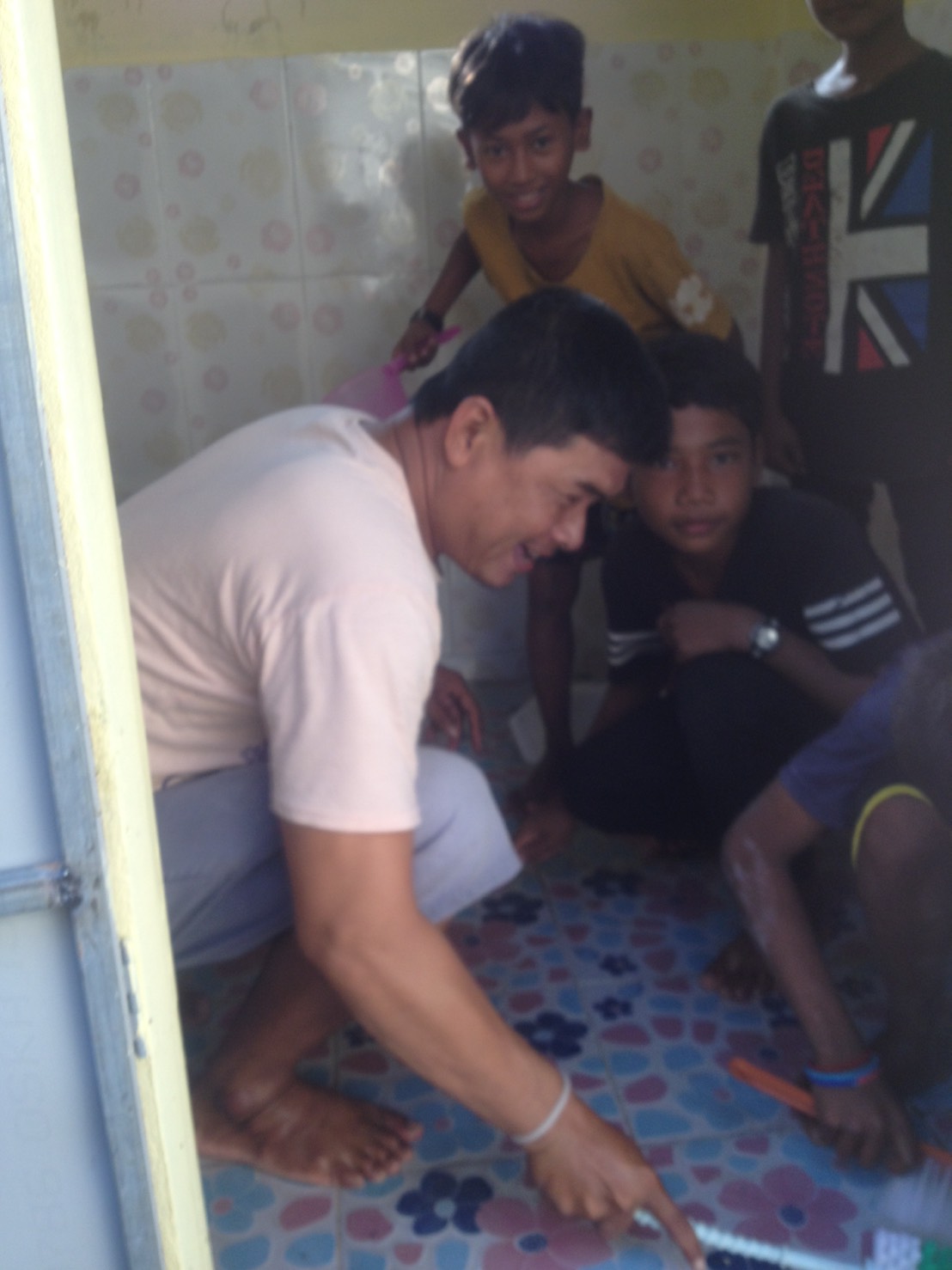

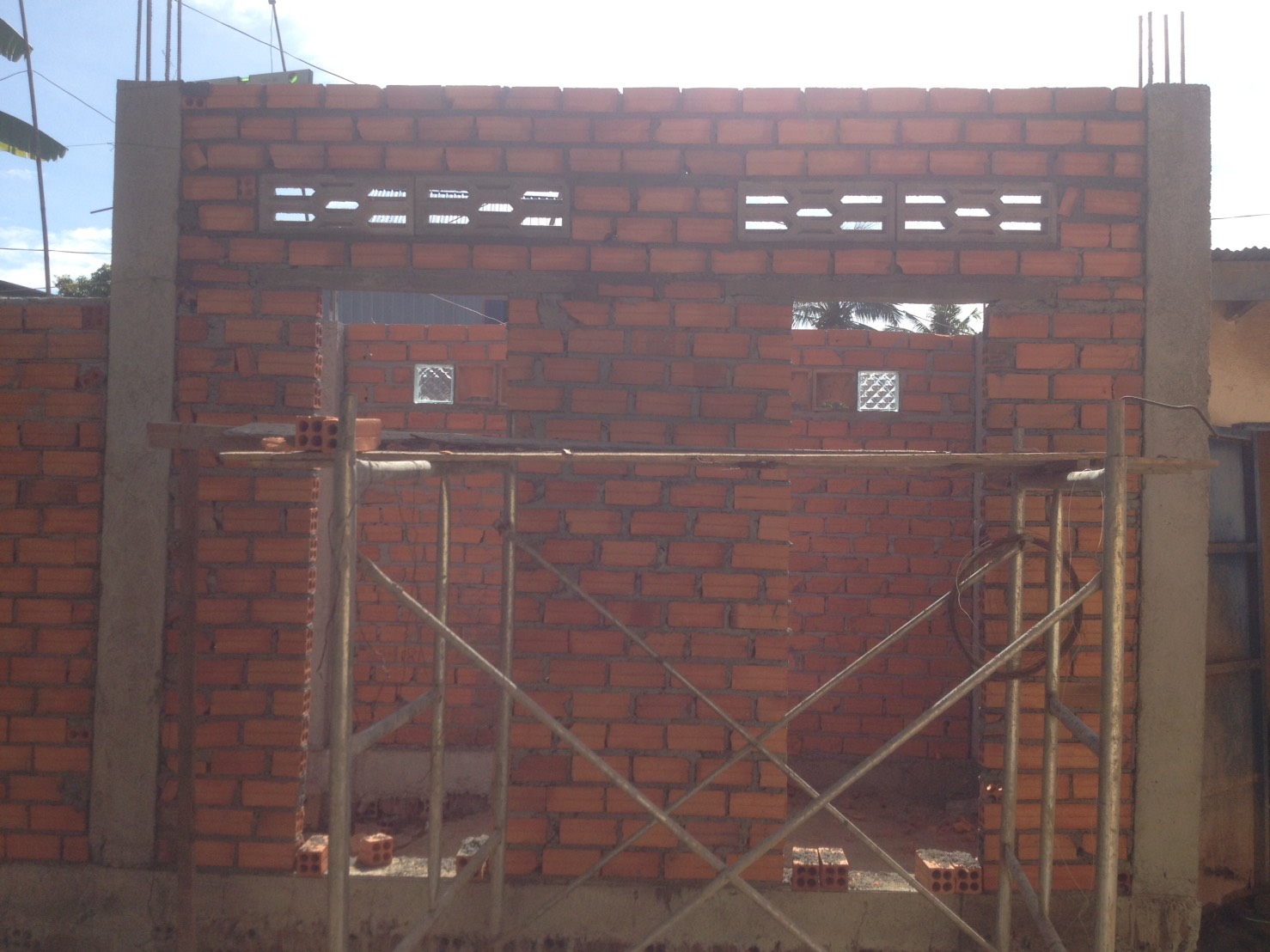

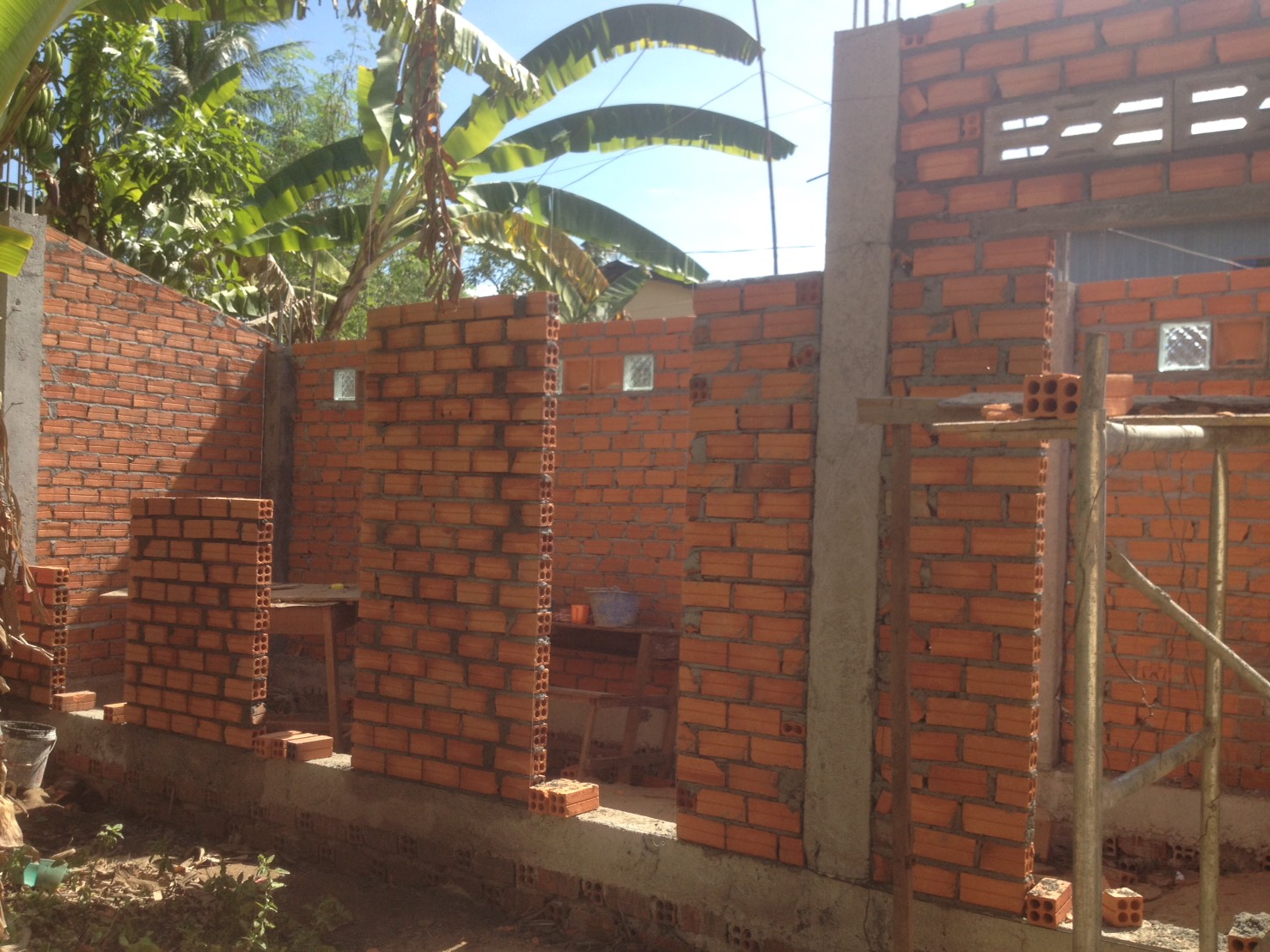

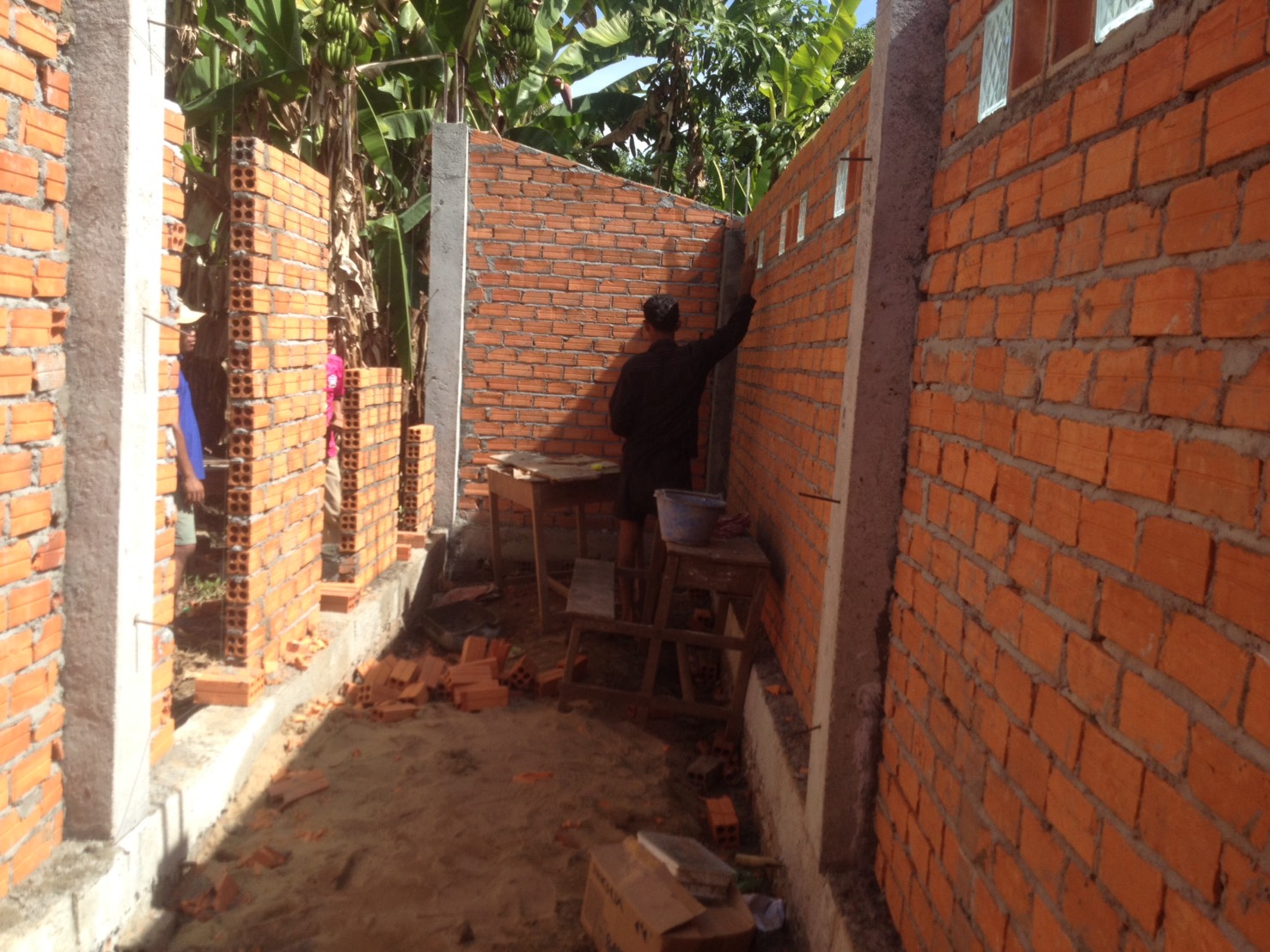

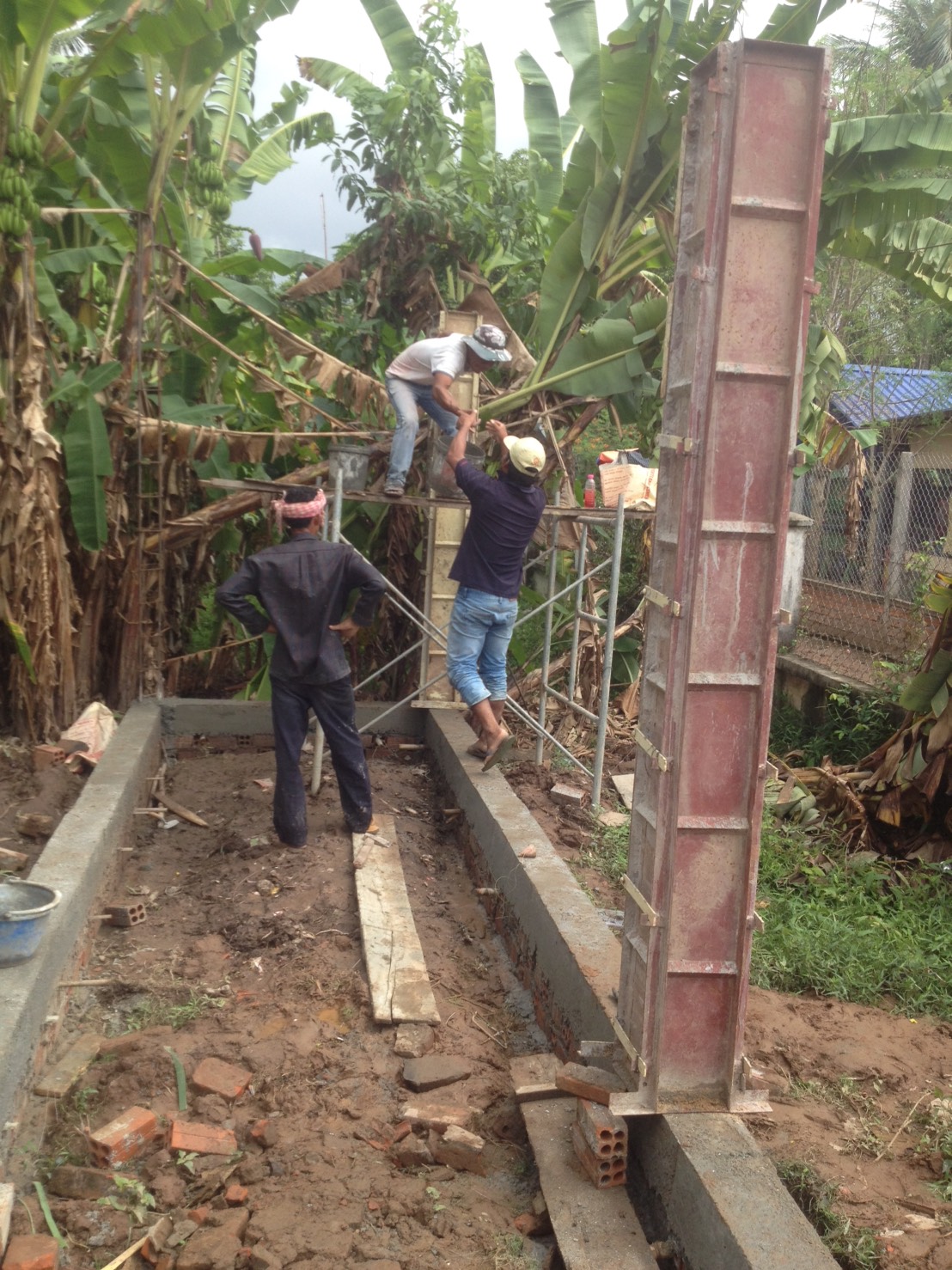

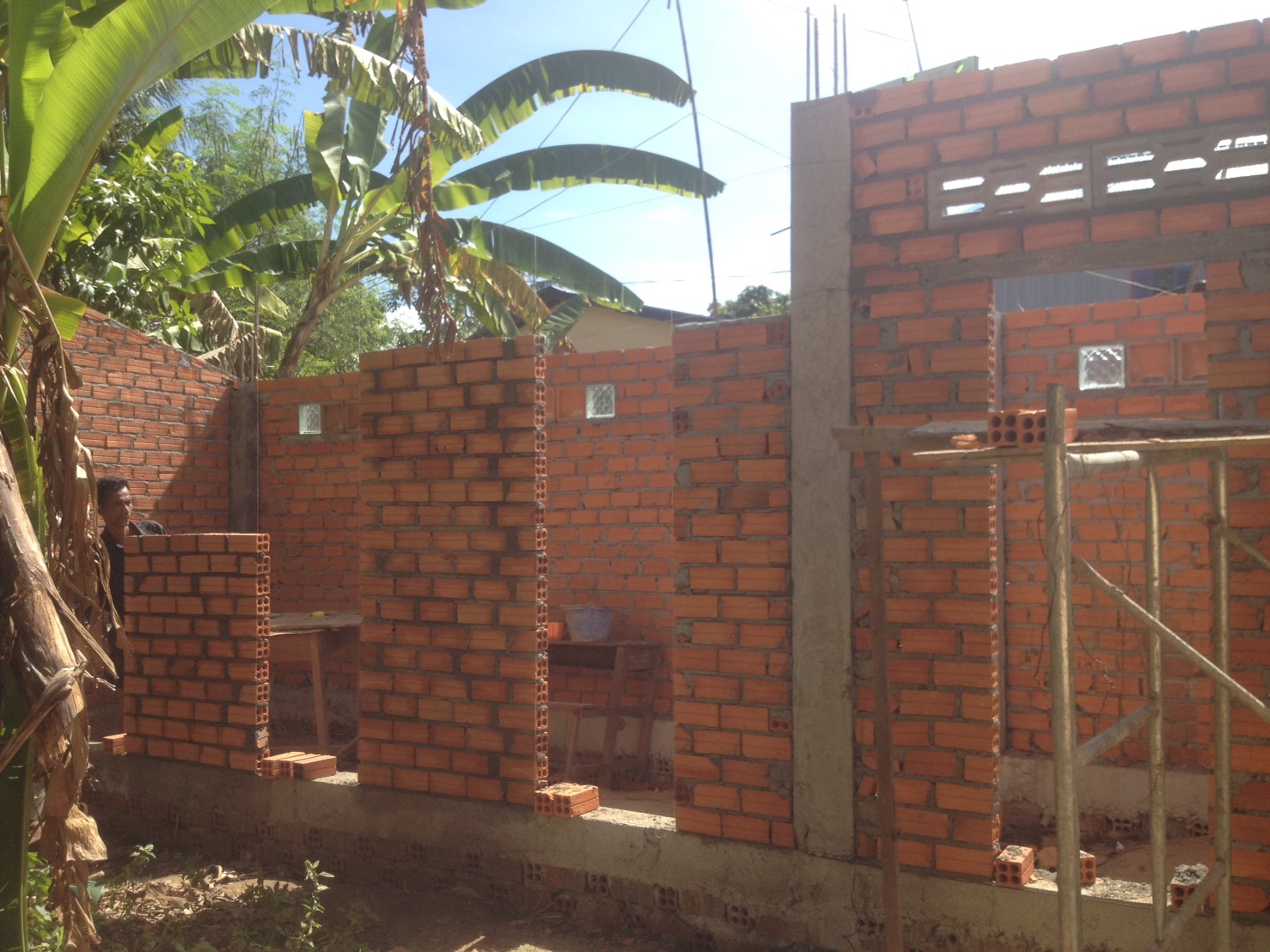

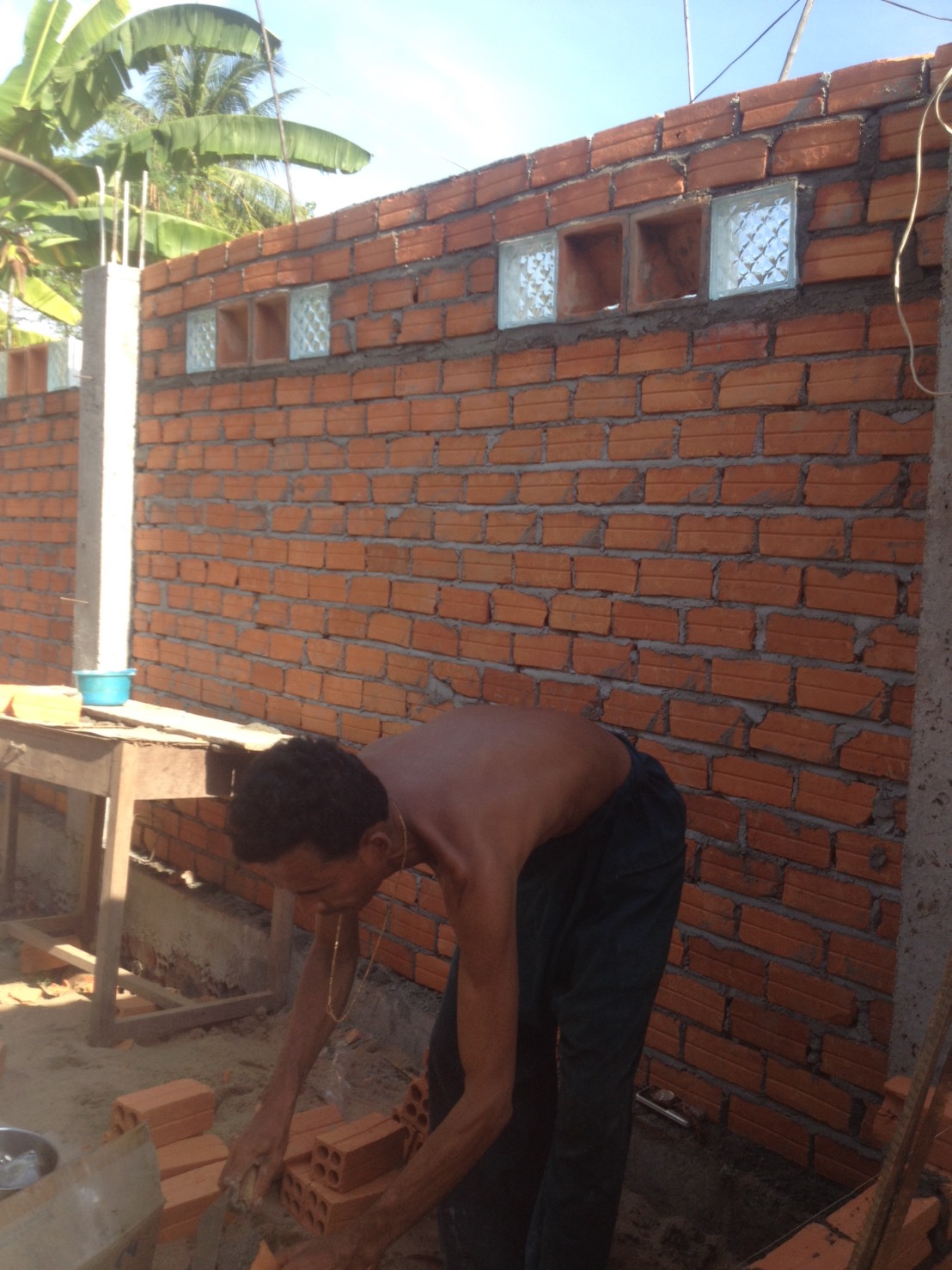

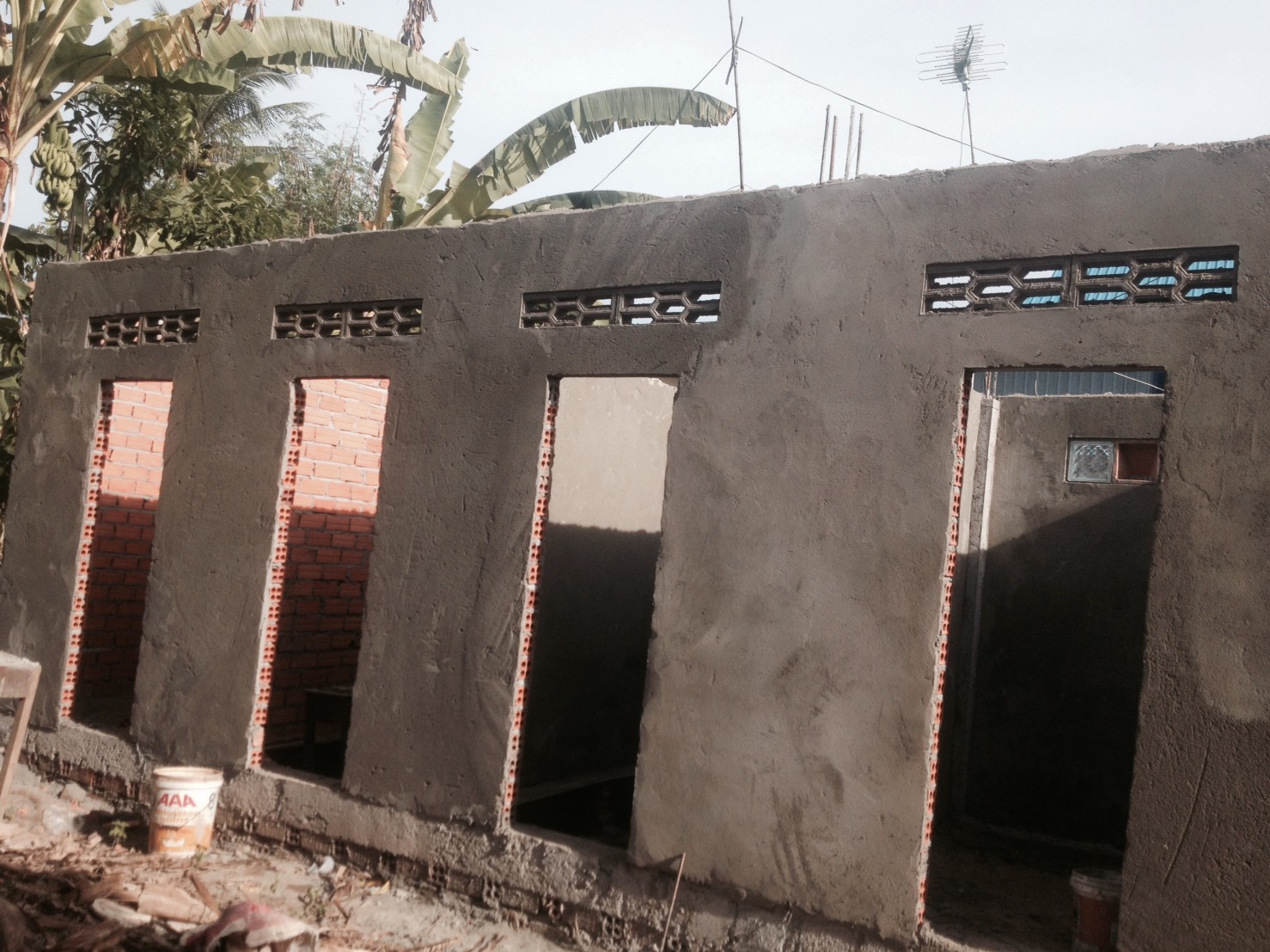

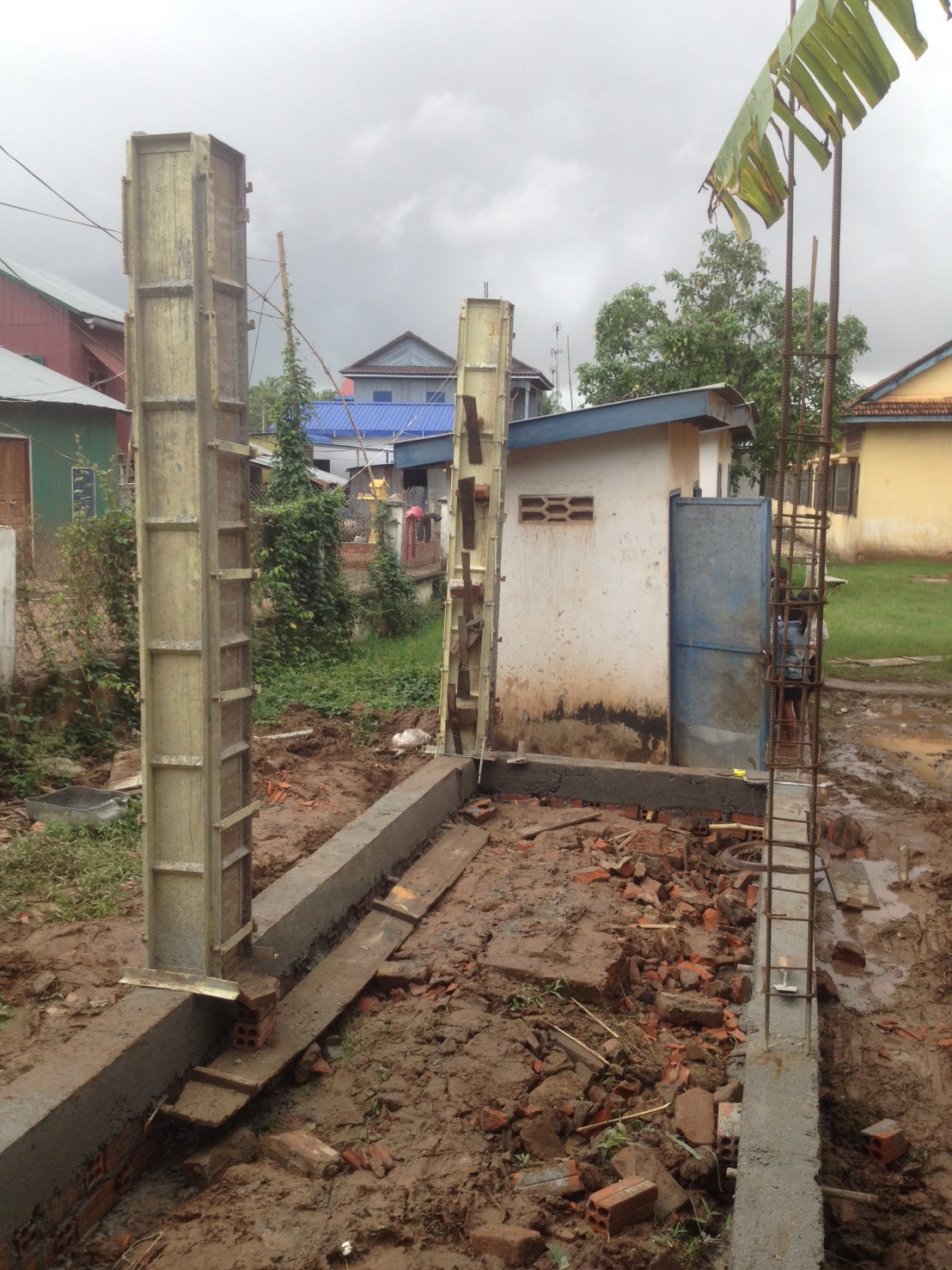

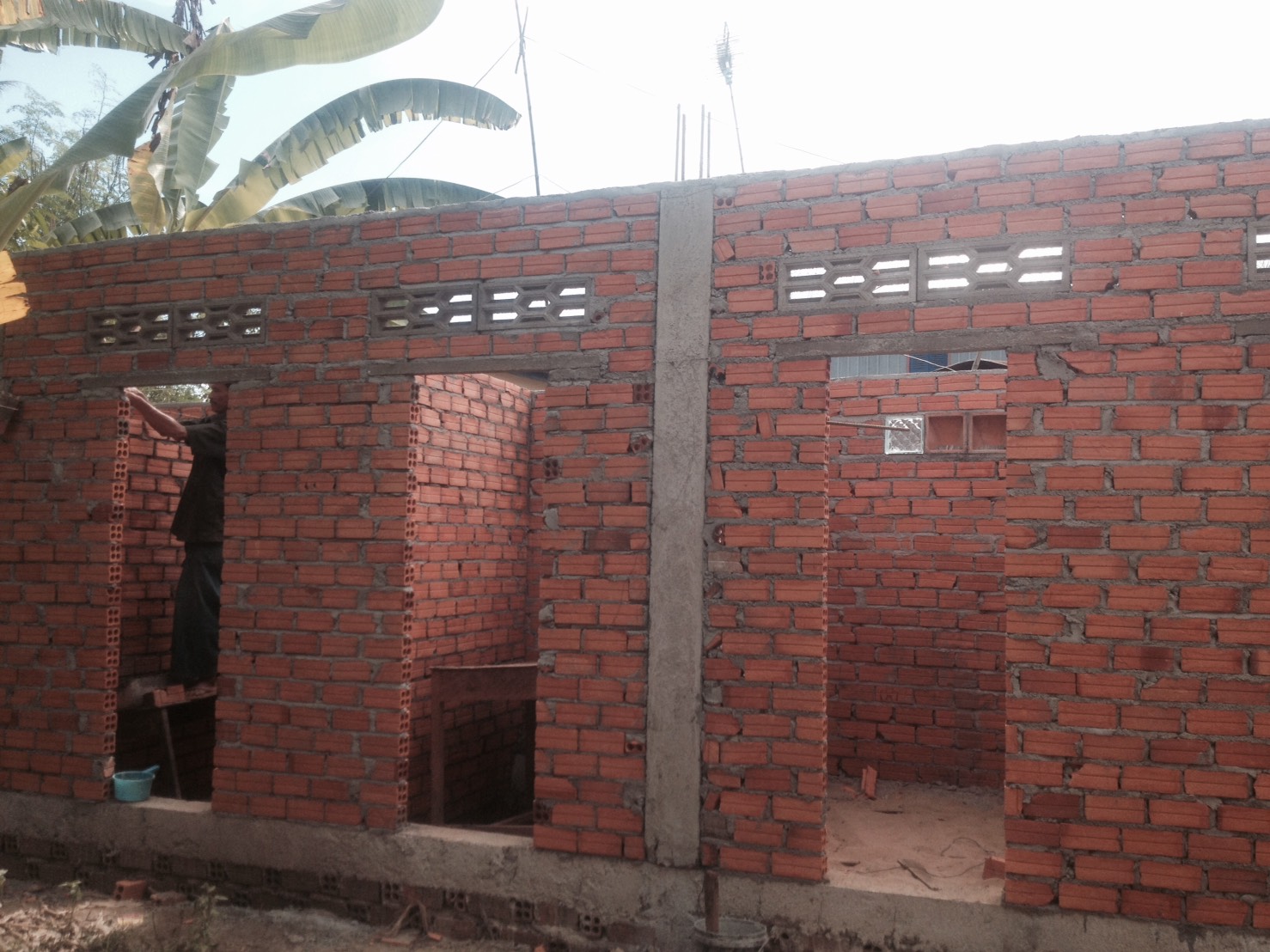

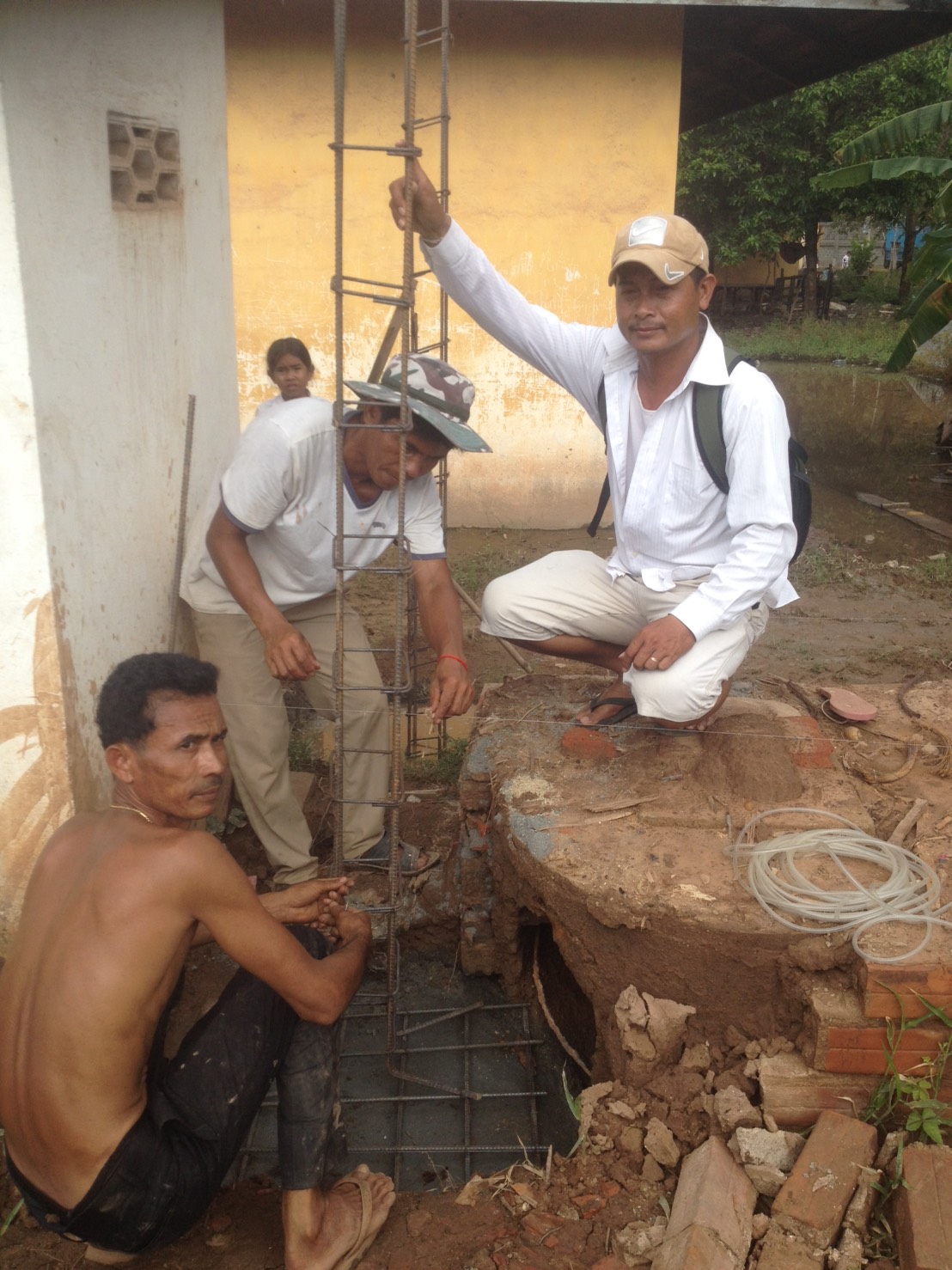

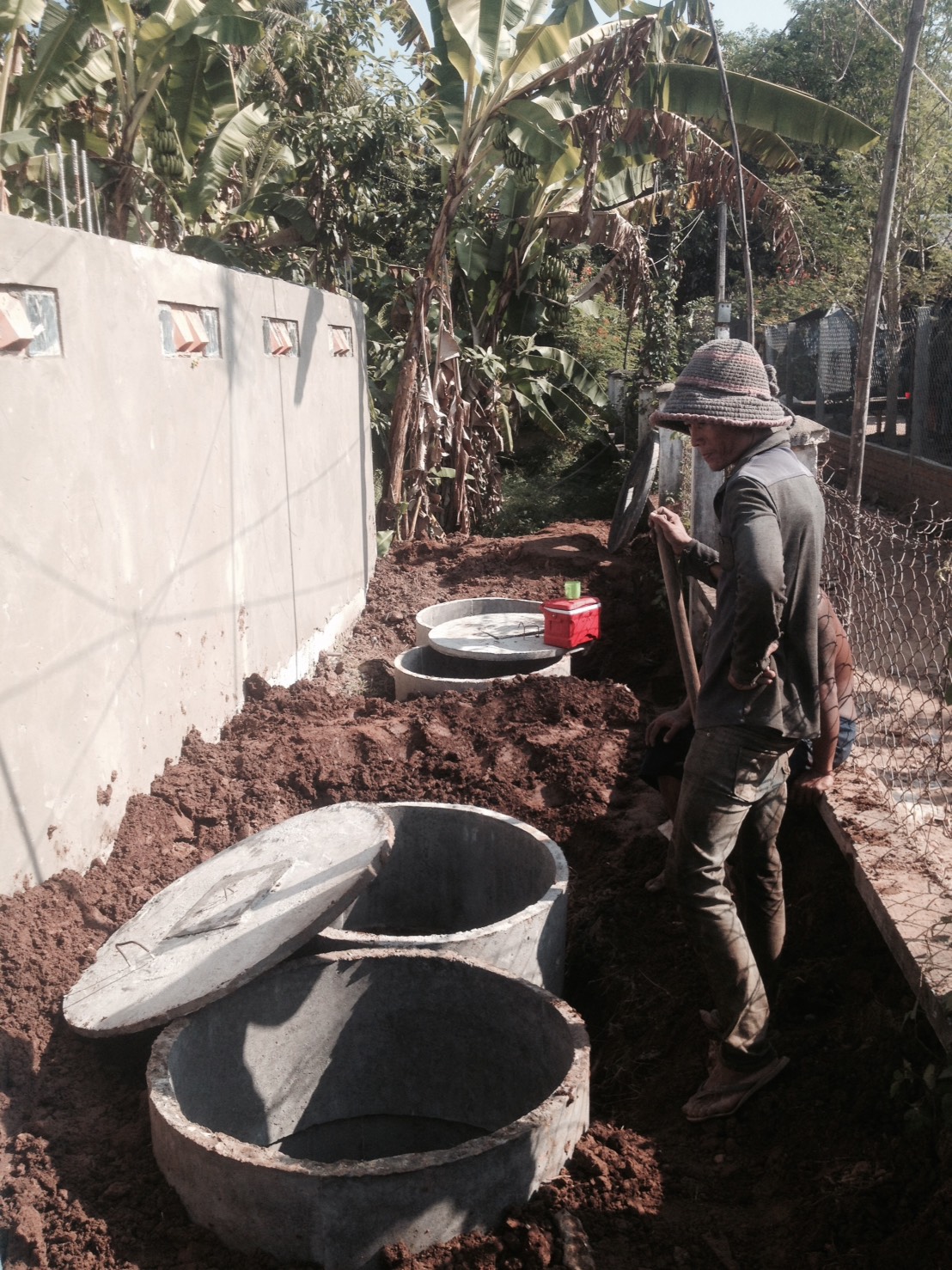

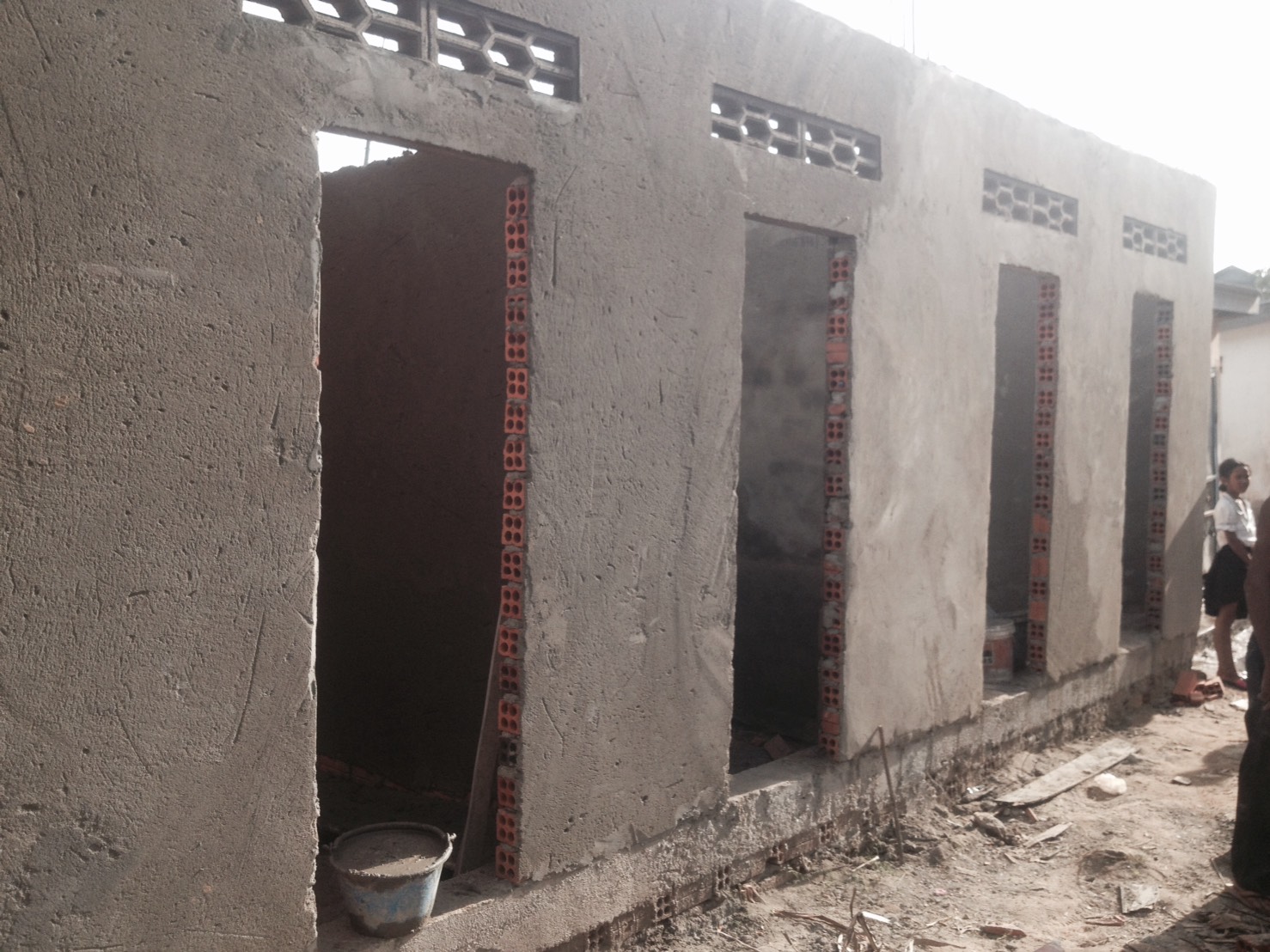

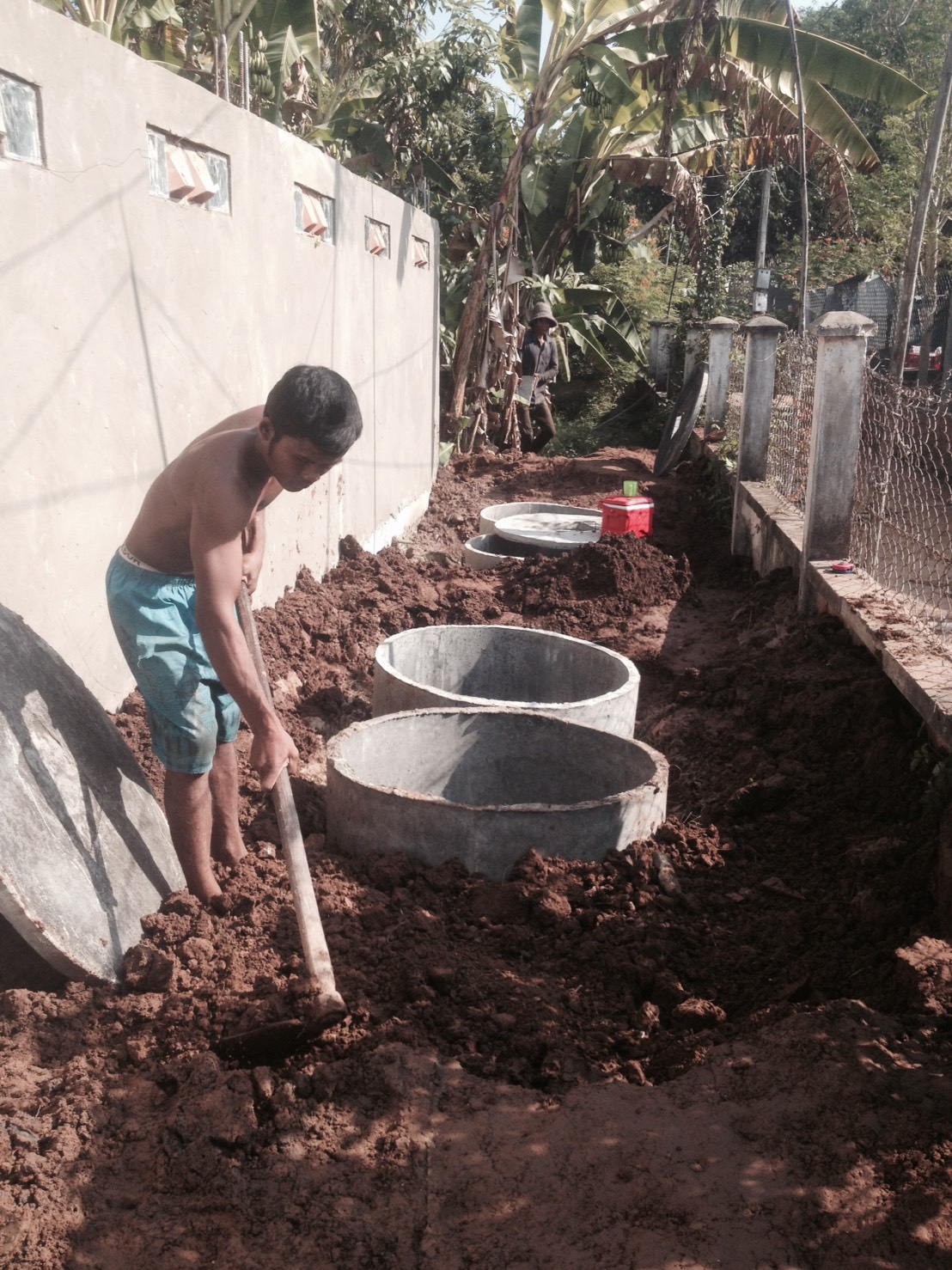

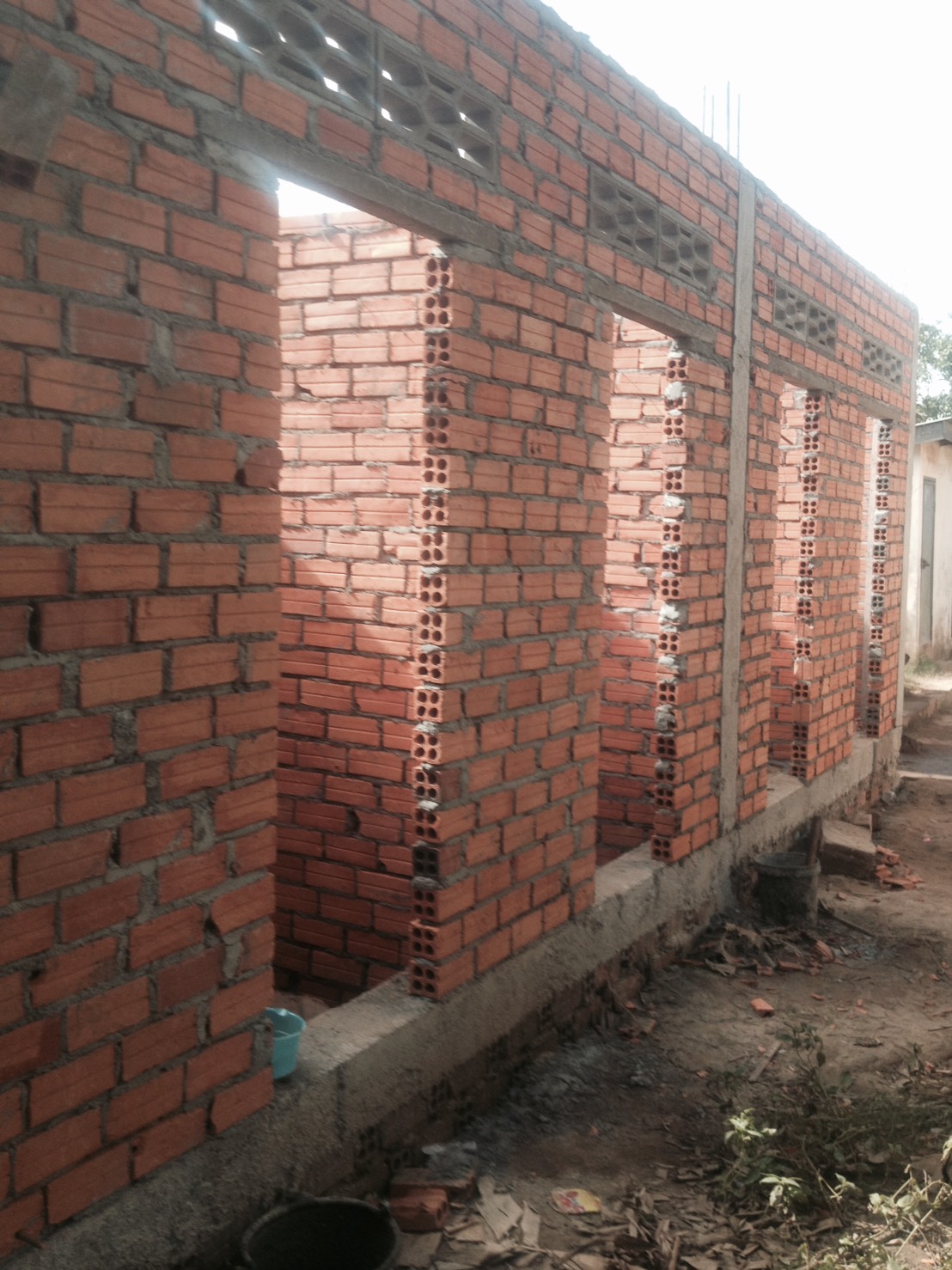

Photo Array - Progress of the Build
(I am not an expert website builder and do not
know how to make the photos a thumb and click to zoom, so for a closer
look please zoom manually, for example in Internet Explorer, Ctrl +
(zoom), Ctrl - (reduce) and Ctrl 0 (back to normal size))
|
|
